When you are building on the Bay Area's notoriously active clay soils, a drilled pier foundation for a commercial building on Bay Area clay soil is not merely one option among many — it is the most reliable structural solution available. Shallow foundations shift, heave, and crack as the clay expands and contracts with seasonal moisture swings, while drilled piers bypass that unstable layer entirely, anchoring your structure to stable bedrock or dense bearing soil far below the zone of movement. Every structural decision you make about your commercial building foundation at the outset will define its performance for decades.

Drilled pier foundation construction for a commercial building on Bay Area expansive clay soil
Figure 1 — A rotary drill rig boring a commercial drilled pier through expansive Bay Area clay to reach stable bearing material below the active zone.

The Bay Area's expansive Vertisols — particularly the Altamont and Los Banos clay series found across the East Bay, South Bay, and portions of the peninsula — rank among the most problematic foundation soils in the United States. These soils can exert uplift pressures exceeding 10,000 pounds per square foot as they absorb moisture, a force capable of buckling slabs, fracturing grade beams, and splitting masonry walls. As detailed in our guide on how expansive clay soil in the Bay Area affects your new home foundation, the shrink-swell behavior of these soils is measurable and predictable — and must be designed around, not ignored.

Drilled pier systems, also called drilled shafts or caissons (cylindrical foundation elements bored into the ground and filled with reinforced concrete), have become the standard commercial foundation answer throughout the Bay Area. They transfer structural loads directly past the problematic clay into competent bearing strata, creating a system that is largely immune to surface-level soil movement. This guide explains what you need to understand before your commercial project breaks ground.

Chart comparing drilled pier depth requirements across Bay Area clay soil types for commercial buildings
Figure 2 — Typical drilled pier depth requirements (in feet) across common Bay Area clay soil series for commercial foundation loads.

Why Bay Area Clay Makes Standard Foundations Unreliable for Commercial Buildings

The Shrink-Swell Cycle and Its Structural Consequences

Bay Area clay soils absorb water during the wet season and release it during the dry season, expanding and contracting by several inches in the process. For a commercial building carrying heavy live loads — warehouse racking, mechanical equipment, or dense occupancy floor systems — that movement creates structural failures that are costly and sometimes irreversible. The vertical heave potential of Bay Area clay regularly exceeds three inches in the upper four feet of soil, a figure that disqualifies shallow spread footings for most commercial applications in affected zones. The clay does not distinguish between a small retail building and a large warehouse — it exerts the same forces regardless of what sits above it.

What a Geotechnical Investigation Actually Reveals

A proper site investigation quantifies the plasticity index (PI, a measure of how much a soil expands when wet) and the potential vertical rise (PVR) of the clay at your specific location. These numbers drive every design decision that follows. The geotechnical report is not a bureaucratic formality — it is the document your structural engineer and the city plan checker will rely on from permitting through construction. Our article on geotechnical report requirements for small commercial buildings in the Bay Area explains what that document must contain to support a deep foundation design.

The Equipment and Methods Behind Drilled Pier Construction

Rotary Drill Rigs and Auger Selection

A drilled pier is constructed using a rotary drill rig equipped with a helical auger (a large screw-shaped bit that bores through soil and rock). Auger diameters for commercial projects typically range from 18 to 36 inches or larger, depending on the load requirements your structural engineer specifies. The rig must be sized to reach the depth your soils report requires — in Bay Area clay conditions, that frequently means drilling 20 to 40 feet below grade, and sometimes deeper where thick clay profiles persist.

Reinforcement Cages and Concrete Placement

Once the hole is bored, workers lower a prefabricated steel reinforcement cage into the shaft before concrete is placed. The cage resists both the compressive loads from the structure above and the uplift forces that expansive clay exerts against the pier's sides. Concrete is placed via a tremie pipe (a tube that delivers concrete to the bottom of the hole) to prevent segregation of the aggregate, particularly when groundwater is present. The quality of concrete placement inside a drilled pier cannot be inspected after the fact, which makes your choice of contractor a structural decision, not merely a procurement one.

Always require a slump test and compressive strength cylinder samples for every pier pour — these records become your only verification of concrete quality after the pier is buried.

Drilled Piers Compared to Other Commercial Foundation Types

Many owners default to spread footings or mat slabs based on cost assumptions that do not hold once expansive soils are factored in. Our detailed breakdown of spread footings vs. mat slab foundations for small commercial buildings covers that trade-off in depth, but the table below shows where drilled piers stand relative to each alternative across the criteria that matter most on Bay Area clay sites.

Foundation TypeBest Soil ConditionPerformance on Bay Area ClayRelative CostSite Access Needed
Drilled PiersDeep expansive clayExcellent — bypasses active zoneModerate–High10–12 ft clearance
Spread FootingsStable, uniform bearingPoor — susceptible to heaveLowMinimal
Mat SlabSoft, compressible soilsFair — still affected by surface heaveModerateMinimal
Driven PilesDense sand or gravel below clayGood — but vibration-intensiveHighModerate
Helical PiersLight loads, restricted accessFair — limited load capacityModerateMinimal

The Real Advantages and Limitations of Drilled Pier Foundations

Where Drilled Piers Consistently Outperform

Drilled piers deliver unmatched performance on Bay Area clay because they carry load to competent material below the active zone, eliminate differential settlement (uneven sinking between foundation points), and resist both the downward loads from the building and the upward forces from swelling soil. A properly designed drilled pier system is the single most reliable insurance against clay-related structural failure for commercial buildings in this region. They also adapt well to sloped sites and irregular lot shapes that would complicate a mat slab pour or require extensive over-excavation with spread footings.

Constraints You Should Weigh Before Committing

Drilled piers cost more upfront than shallow alternatives, and drill rig mobilization adds a fixed expense regardless of project size. The equipment also requires site access with adequate vertical clearance — roughly 10 to 12 feet minimum — which can be a real constraint on tight infill urban lots. If boring encounters cobbles, boulders, or cemented layers, progress slows and costs rise. A thorough geotechnical report reviewed by your structural engineer before bidding is the only way to quantify these risks with any confidence.

Request borings from at least two locations per site before finalizing your foundation budget — subsurface conditions can vary dramatically across a single commercial lot in the Bay Area.

Pre-Construction Steps That Set Your Commercial Project Up for Success

Commissioning the Right Geotechnical Investigation

Your geotechnical report is the foundation of your foundation design, and it must be site-specific. It should include Standard Penetration Test (SPT) borings to the anticipated pier depth, soil classification with PI and PVR measurements, groundwater depth, and a seismic site class determination. Sites near the Bay or low-lying creek corridors require particular attention to liquefaction potential — a topic covered in our article on how liquefaction zones affect commercial foundation design in the Bay Area. Commission the report before engaging your structural engineer so the design is built on real site data from day one.

Coordinating the Permit Process Before Ground Breaks

Commercial foundation permits in Bay Area cities involve multiple review cycles — planning, structural, soils, and typically a special inspection program for deep foundations. Beginning the permit process the moment your geotechnical report is complete can shave months off your overall project schedule. Our guide on the commercial foundation permit process in Bay Area cities explains exactly what contractors need to prepare at each stage. Many jurisdictions also require a third-party special inspection firm to be approved and listed on the permit before any drilling begins.

Errors That Derail Commercial Drilled Pier Projects in the Bay Area

Underinvesting in the Soil Investigation

The single most expensive mistake on commercial drilled pier projects is relying on a minimal or generic soils report. A report that does not include borings to pier depth, does not quantify the expansive potential of the clay, or does not address seismic hazard will produce a design that either overbuilds (wasting your budget) or underbuilds (endangering the structure). The cost of a thorough geotechnical investigation typically represents less than one percent of your total project budget, making it the highest-return expenditure on the entire job. Do not negotiate on its scope.

Overlooking Seismic and Liquefaction Zones

Bay Area commercial projects must account for seismic loading in addition to static gravity loads from the building. Drilled piers in seismic zones must be designed with ductile (flexible and energy-absorbing) reinforcement detailing at the pier cap to survive lateral forces during an earthquake without fracturing at the column connection. Sites near the Bay or along creek corridors may also fall within mapped liquefaction hazard zones, requiring additional engineering measures that are not part of a standard pier design. Ignoring these requirements at the design stage leads to expensive redesigns or outright permit rejections.

Never allow the special inspection requirement for drilled piers to be cut from the project — it is a code requirement for a reason, and waiving it creates liability that no budget savings can justify.

Misconceptions About Drilled Pier Foundations You Should Stop Believing

Myth: Extra Rebar Fixes Any Foundation on Clay

Adding reinforcing steel to a shallow footing does not solve the underlying problem — the soil still moves, and the footing moves with it. Rebar helps a foundation resist cracking under load, but it cannot prevent the heave force that expansive clay exerts against the bottom of a shallow foundation element. The only way to eliminate clay heave as a structural threat is to carry your loads below the active zone, which is precisely what drilled piers accomplish. More steel in a flawed design is still a flawed design, and it will still fail on Bay Area clay over time.

Myth: Drilled Piers Are Only Justified for Large or Multi-Story Buildings

Many developers assume drilled pier systems are reserved for multi-story structures or large-footprint projects. This assumption is incorrect and routinely costs owners money in repair bills. A single-story retail building or a small office on Bay Area clay can experience the exact same destructive heave forces as a larger structure — the soil does not moderate its behavior based on the number of floors above it. The appropriate foundation type is determined by soil conditions and structural loads, not by building height. You can review background on drilled pier construction from Wikipedia to understand how broadly this foundation type is applied across building scales and project types worldwide.

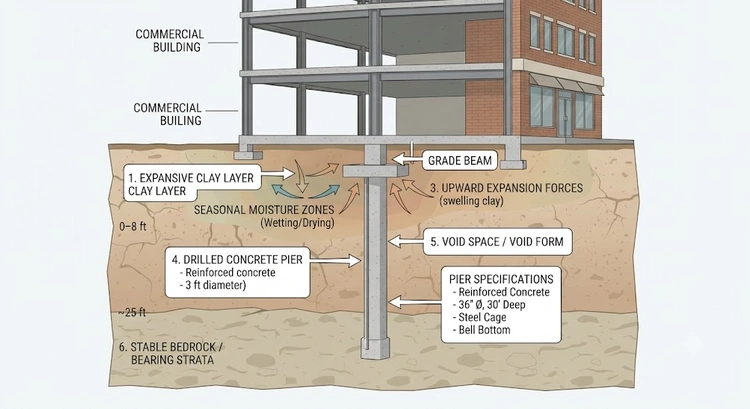

Infographic showing drilled pier foundation anatomy and load path through Bay Area expansive clay soil layers
Figure 3 — Anatomy of a commercial drilled pier foundation showing load transfer through active clay zones into stable bearing material below.

Frequently Asked Questions

How deep do drilled piers need to go in Bay Area clay soils?

The required depth depends on your site's specific soil profile, but most commercial drilled piers in Bay Area clay extend between 20 and 50 feet below grade. Your geotechnical engineer specifies the minimum depth needed to reach material with adequate bearing capacity and to pass below the active zone where clay movement occurs. Never specify a target depth without site-specific boring data to support that number.

How much do drilled pier foundations cost for commercial buildings in the Bay Area?

Commercial drilled pier projects in the Bay Area typically run between $150 and $400 per linear foot of pier, including drilling, reinforcement cage, and concrete. Drill rig mobilization adds a fixed cost that is spread across all piers on the project. A complete pier and grade beam system for a small commercial building often falls between $80,000 and $250,000 before the slab and above-grade work begins, though site conditions and pier diameter can push costs higher or lower on any specific job.

Do drilled pier foundations require special inspections during construction in the Bay Area?

Yes, without exception. California building codes and most Bay Area jurisdictions require continuous or periodic special inspection during drilled pier construction, including verification of bearing material at the bottom of each pier, review of the reinforcement cage before concrete placement, and concrete testing for strength and workability. Your structural engineer of record specifies the inspection program in the construction documents, and the inspection firm must be pre-approved by the building department before drilling begins.

On Bay Area clay, the depth of your foundation is not a line item to negotiate — it is the entire reason the building stands.
