Have you ever submitted a commercial foundation permit Bay Area application only to watch weeks turn into months while your project sits idle? The answer — and how to prevent it — comes down to knowing exactly what each city requires before you break ground. If you're preparing to pour footings for a retail building, a mixed-use development, or a light industrial facility, the permit process across San Francisco, Oakland, San Jose, and surrounding Bay Area cities follows consistent principles with critical local variations. Getting approval on the first submittal is not luck. It is preparation. Start with a clear understanding of what the commercial building foundation process demands, and you will stay ahead of the delays that routinely push commercial projects months off schedule.
Bay Area cities are among the most complex permitting jurisdictions in California. Each operates under the California Building Code but layers on local amendments, seismic requirements, and environmental review triggers that vary by municipality and project size. A commercial foundation permit in San Jose follows a different review pathway than the same permit in San Francisco, even if the structure and footprint are nearly identical.
The contractors who move fastest through these systems share one trait: they treat the permit process as a construction phase, not an administrative afterthought. That mindset — planning for permitting the way you plan for excavation — is what this post covers in detail.
Contents
- Essential Steps for a Smooth Commercial Foundation Permit Submission
- How Permit Timelines Differ Across Bay Area Cities
- Clearing Up Misconceptions About Commercial Foundation Permits
- Documentation and Digital Tools That Speed Permit Approvals
- Building a Permit Strategy That Protects Every Future Project
- Frequently Asked Questions
- Key Takeaways

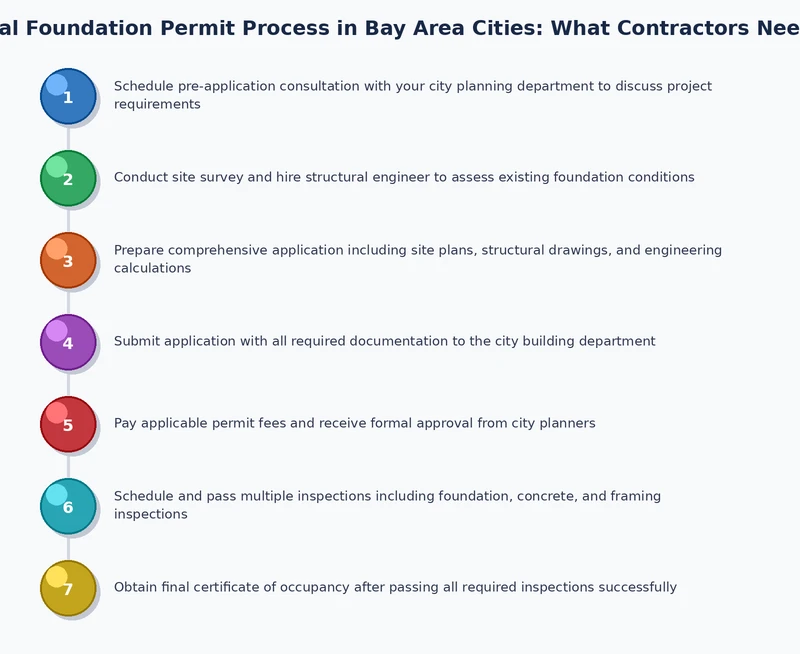

Essential Steps for a Smooth Commercial Foundation Permit Submission
The commercial foundation permit Bay Area process begins well before you submit a single document. Cities including San Francisco, Oakland, San Jose, Fremont, and Sunnyvale all require a structured pre-submittal phase. Skipping it is the single most common reason commercial foundation projects face correction cycles that extend timelines by six to twelve weeks.
Pre-Application Site Assessment
Your first obligation is to understand what sits beneath the proposed building footprint. Bay Area soils are notoriously variable — expansive clays in the East Bay, loose alluvial deposits near the waterfront, and fill soils throughout much of San Francisco. A geotechnical investigation is not optional for commercial work. It drives every design decision your structural engineer will make about footing depth, bearing capacity, and reinforcement.
Understanding how liquefaction zones affect commercial foundation design in the Bay Area is not a secondary concern — it directly determines whether you will need a special inspection program, deep piers, or ground improvement. In Oakland, Berkeley, and parts of San Jose, liquefaction hazard zones trigger additional review requirements that are invisible until you pull the parcel records. Before preparing your submittal, confirm the following:
- Parcel zoning and any special overlay zones (liquefaction, fault, flood)
- Whether a geotechnical report is required for your project's size and occupancy classification
- Local fire, planning, and public works sign-off requirements
- Whether the project triggers California Environmental Quality Act (CEQA) review
Assembling Your Permit Package
A complete permit package for a commercial foundation in the Bay Area typically includes architectural plans, structural drawings, a soils and geotechnical report, and a special inspection program. Most jurisdictions also require a project data sheet, energy compliance documentation, and accessibility compliance notes — even when the foundation permit is submitted as a standalone ahead of the full building permit.
Pro Tip: Submit your geotechnical report simultaneously with your structural drawings. Cities that review them sequentially will flag your structural sheets if the geotech hasn't cleared first, adding weeks to your timeline with no benefit to anyone.
What a soil report tells your foundation engineer — and by extension your structural engineer — shapes the entire drawing set. Attempting to finalize structural documents before the geotech report is complete is a direct path to correction letters.
Coordinating With the Plan Check Team
Most Bay Area jurisdictions offer a pre-application conference. Use it. A 45-minute meeting with a plan checker before submittal can expose department-specific formatting preferences, local code amendments, and project-specific concerns that won't appear anywhere in the published guidelines. Bring your structural engineer to this meeting, not just an office administrator.
After submittal, respond to correction letters within the jurisdiction's specified response window. Delayed responses reset your position in the review queue in many cities. San Francisco's Department of Building Inspection moves corrections to the back of the stack if a response isn't received within the defined window — and that delay compounds fast.

How Permit Timelines Differ Across Bay Area Cities
The commercial foundation permit Bay Area landscape is not uniform. A project that clears plan check in three weeks in Sunnyvale can sit in queue for ten weeks in San Francisco. These differences are structural — staffing levels, digital submission infrastructure, and local code amendment complexity all play a role. Understanding the variance is essential for accurate project scheduling.
San Francisco, Oakland, and San Jose Compared
The table below summarizes typical permit timelines and key requirements across the region's major cities. These are representative ranges based on project complexity, from straightforward slab-on-grade pours at the lower end to engineered deep foundation systems at the upper end.
| City | First Plan Check (weeks) | Avg. Correction Rounds | Digital Submission Platform | Notable Local Requirements |
|---|---|---|---|---|
| San Francisco | 8–14 | 2–3 | ProjectDox | SF local amendments, mandatory soil reports for Class E soils |
| Oakland | 6–10 | 1–2 | eTRAKiT | Liquefaction zone review, infrastructure sign-off requirements |
| San Jose | 4–8 | 1–2 | Accela | Special inspection program required for commercial foundations over 500 sq ft |
| Fremont | 5–9 | 1–2 | CityGov | Expansive soil documentation required in hillside zones |
| Sunnyvale | 4–7 | 1 | Online portal | Over-the-counter review available for certain small commercial projects |
The disparity in processing times is real and significant. If you're managing multiple projects across jurisdictions, sequence your submittals with San Francisco first. Its longer lead time will pace the entire portfolio timeline if you submit everything simultaneously.
What Experienced Contractors Do Differently
Contractors who consistently hit their project schedules don't just submit permits earlier. They do several specific things that compound in value over time:
- They maintain a jurisdiction-specific checklist updated after every project
- They designate a single point of contact at each building department who knows their projects by name
- They schedule the structural engineer's correction response meeting before correction letters even arrive
- They use permit expediters for San Francisco DBI, where timeline variability is the highest in the region
The parallel permitting approach — submitting to multiple departments simultaneously rather than sequentially — is the highest-leverage tactic available. In cities where planning, public works, and building permit submittals can run in parallel, you can cut four to eight weeks from a typical commercial foundation timeline without changing anything about the project itself.
Clearing Up Misconceptions About Commercial Foundation Permits
Several widely held beliefs about the commercial foundation permitting process lead contractors and owners directly into avoidable delays. These aren't edge cases. They come up on nearly every commercial foundation project in the Bay Area.
Myth: One Submittal Is Always Enough
Expect correction rounds. In the Bay Area, the first correction letter is almost always guaranteed on commercial foundation projects. Plan checkers flag missing details, request clarifications, or cite local code amendments not addressed in the original set. The question isn't whether you'll receive corrections. It's how quickly you can respond and how complete your next submittal will be.
The way to minimize correction rounds is to over-document on the first submittal. Every structural detail, every special inspection note, every soils reference on the drawings. Incomplete submittals are far more costly than thorough ones.
Myth: Commercial and Residential Permits Work the Same Way
They don't. Commercial foundation permits in Bay Area cities trigger review pathways that residential permits do not. Fire, planning, public works, and sometimes environmental health are all required sign-offs on commercial work. The review typically involves multiple departments that must clear in a specific sequence — not a single building department review like most residential projects.
Warning: Treating a commercial foundation permit like a residential application is one of the most reliable ways to add twelve or more weeks to your timeline. Department routing alone can consume several weeks if you haven't confirmed the sequence upfront.
If you're familiar with residential permitting in the Bay Area — for a concrete driveway, for instance — understand that residential permit requirements like a San Jose concrete driveway permit represent a fraction of the documentation and inter-department coordination that commercial foundation work demands.
Myth: Posted Permit Timelines Are Guarantees
Published timelines are targets, not guarantees. Staffing changes, third-party plan check backlogs, and project-specific complexity all push timelines beyond estimates. Build a minimum eight-week buffer into any commercial schedule that depends on Bay Area permit approval. Extend that to twelve weeks for San Francisco or projects with complex seismic or soil conditions.
According to the California Building Standards Commission, local jurisdictions are permitted to adopt requirements more stringent than the statewide code — which is exactly what every Bay Area city does. That local variation is the primary driver of timeline unpredictability across the region.
Documentation and Digital Tools That Speed Permit Approvals
The shift to digital submission has fundamentally changed the commercial foundation permit Bay Area workflow. Every major Bay Area city now accepts or requires electronic plan submittal. But the tools vary by jurisdiction, and submitting the wrong file format or missing a required metadata field can bounce your application before a plan checker ever reviews it.
Required Documents Checklist
For a standard commercial foundation permit across most Bay Area jurisdictions, your submittal package should include the following:
- Structural drawings: Foundation plan, footing details, reinforcement schedules, and a general notes sheet
- Geotechnical/soils report: Signed and stamped by a licensed California geotechnical engineer
- Special inspection program: Required for most commercial foundations in Seismic Design Category D or higher
- Architectural site plan: Showing setbacks, property lines, and existing site conditions
- Structural calculations: Often reviewed separately from the drawing set, especially in San Francisco
- Energy compliance documentation: Title 24 report if the foundation permit is submitted as part of the building permit
- Project data sheet: Occupancy classification, construction type, square footage, and project valuation
Bay Area soil conditions add documentation layers beyond what you'd encounter in other California regions. Understanding how Bay Area soil conditions affect foundation design directly determines how detailed your soils documentation needs to be — and in high-plasticity clay zones or fill areas, the requirements are substantial.
Submission Platforms and Software
Each city's digital submission platform has its own conventions. San Francisco's ProjectDox requires specific PDF layer structure and naming conventions. Oakland's eTRAKiT has file size limits that trip up large drawing sets. San Jose's Accela portal is considered the most user-friendly in the region but still requires applicant registration and project setup before the first submittal.
Within your office, the tools that consistently reduce correction rounds include:
- BIM coordination software (Revit, Navisworks) for clash detection before drawing submittal
- PDF markup platforms (Bluebeam) for tracking comment resolution across correction rounds
- Project management software (Procore, Buildertrend) for sequencing permit milestones across multiple active projects
- Portal monitoring tools that alert you when your plan check status changes in city systems
Don't underestimate PDF hygiene. Plan checkers across Bay Area cities consistently cite improperly layered PDFs, missing bookmarks, and non-searchable text as reasons for returned submittals — before plan check even begins.
Building a Permit Strategy That Protects Every Future Project
The contractors who operate most efficiently across Bay Area commercial foundation permit jurisdictions treat permitting as a discipline — not a one-time task. They build institutional knowledge, maintain city-specific relationships, and create reusable infrastructure that cuts prep time on every future project.
Establishing Relationships With Plan Checkers
Relationship capital with plan checkers is real and measurable. Contractors who are known quantities at a building department consistently get faster informal feedback on marginal issues than those submitting for the first time. That doesn't mean special treatment. It means plan checkers are more likely to call with a quick question rather than issuing a formal correction that resets your review timeline.
The way to build these relationships is straightforward: respond to corrections promptly, be respectful in every interaction, and acknowledge errors without argument. Returning to a city where you've had positive prior engagements carries compounding value across multiple projects.
Seismic compliance is a recurring checkpoint for commercial work throughout the Bay Area. Understanding what seismic requirements actually cost in the Bay Area helps you frame these obligations clearly for clients — and sets accurate expectations about what compliance adds to the overall project budget.
Creating Reusable Permit Templates
Standardize what you can. If you regularly build similar commercial structures — retail pads, small office buildings, warehouse additions — your structural engineer can develop a library of pre-reviewed detail packages that dramatically reduce plan check revision cycles. Some Bay Area jurisdictions maintain lists of pre-approved standard details that, when referenced correctly, do not require individual review.
Build your own internal submittal checklist for each city where you work regularly. Update it after every project with new requirements or reviewer preferences you encounter. Over three to five projects in a single jurisdiction, this checklist becomes one of your most valuable operational assets.
The same discipline applies post-permit. Tracking which structural details sailed through review versus which drew corrections gives your engineering team a feedback loop that tightens the drawing set over time. If you're evaluating foundation system options early in design, reviewing the differences between slab-on-grade and raised foundation systems in the Bay Area can help you select the approach most likely to move cleanly through plan check for a given site condition.
Frequently Asked Questions
How long does a commercial foundation permit take in Bay Area cities?
Timeline varies significantly by city. San Jose typically runs four to eight weeks for a first plan check response, while San Francisco can stretch to eight to fourteen weeks. Project complexity, submittal completeness, and correction rounds all affect the final number. Budget a minimum eight-week window for most Bay Area cities and extend to twelve weeks for complex projects or anything going through San Francisco DBI.
Is a geotechnical report required for all commercial foundation permits in the Bay Area?
Not universally, but it is required in the majority of cases. Projects in mapped liquefaction zones, on fill soils, or above certain square footage thresholds will require a signed and stamped report from a licensed California geotechnical engineer. Even when not strictly required, submitting a soils report typically reduces structural correction rounds and speeds overall approval.
Can I submit commercial foundation drawings digitally in all Bay Area cities?
Yes. Every major Bay Area city now accepts or requires digital plan submittal. San Francisco uses ProjectDox, Oakland uses eTRAKiT, and San Jose uses Accela. Each platform has specific file format requirements, naming conventions, and file size limits — confirm these details before submittal to avoid having your application bounced on administrative grounds.
Do commercial foundation permits require a special inspection program?
In most cases, yes. Commercial foundations in Seismic Design Category D or higher — which applies to most of the Bay Area — require a special inspection and testing program as a condition of permit issuance. The program must be submitted and approved before the permit is issued, and licensed special inspectors must perform on-site inspections during construction.
What causes the most commercial foundation permit corrections in Bay Area cities?
Incomplete structural drawings and missing or mismatched soils report references are the two leading drivers of correction letters. Failure to address local seismic amendments, incomplete special inspection programs, and improperly formatted PDF submittals also generate corrections consistently. A thorough pre-submittal review against the specific jurisdiction's checklist eliminates most of these before they reach a plan checker.
How do I expedite a commercial foundation permit in San Francisco?
San Francisco DBI offers an expedited plan check service for an additional fee. Third-party plan check through an approved consultant is another option that can significantly reduce the timeline for complex projects. For projects where schedule is critical, an experienced permit expediter who maintains active relationships with DBI staff can shorten the process by several weeks compared to a standard over-the-counter submittal.
Key Takeaways
- The commercial foundation permit Bay Area process varies sharply by city — San Jose and Sunnyvale move significantly faster than San Francisco, and each jurisdiction has distinct documentation requirements and department routing you must confirm before submittal.
- A complete first submittal — including the geotechnical report, structural drawings, special inspection program, and project data sheet — is the single highest-leverage action for reducing correction rounds and compressing your overall timeline.
- Treat the permit process as a construction phase: start it early, run parallel department reviews wherever possible, and respond to every correction letter immediately to avoid losing your queue position.
- Jurisdiction-specific checklists and relationships with plan checkers compound in value over multiple projects, cutting prep time and correction risk on every future commercial foundation submittal you make.
