A few months ago, a developer reached out to us in a cold sweat. Their commercial foundation pour was scheduled for Tuesday, and they'd just discovered — on Sunday evening — that half their inspection documentation was sitting in someone's email draft folder, never submitted. No embedment logs, no placement records, nothing officially signed off on the rebar layout. It was fixable, but it cost them a three-day schedule hit and an emergency filing fee that stung. A solid commercial foundation inspection checklist Bay Area contractors use systematically would have caught every gap before it became a crisis. If you're managing a commercial build here in the Bay Area, our commercial foundation services team works with projects exactly like yours — and we know how to keep inspections on track.

commercial foundation inspection checklist Bay Area site showing rebar placement and embedment depth verification before concrete pour

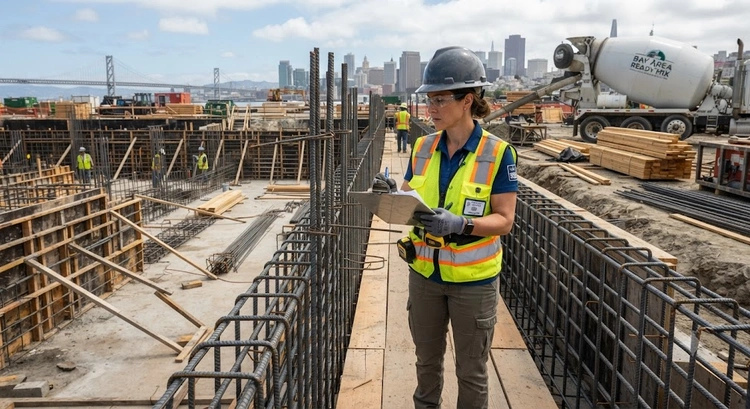

Figure 1 — Rebar placement verification and embedment depth confirmation are among the most scrutinized items on any Bay Area commercial foundation inspection.

Bay Area commercial foundation inspections are more demanding than most developers expect — especially if you're coming from other markets. You're dealing with Seismic Design Category D and E zones, expansive Merritt clay and serpentine soils, and a patchwork of jurisdictions that each interpret CBC standards slightly differently. San Francisco, San Jose, Oakland, and unincorporated Santa Clara County don't all call for the same documentation at the same inspection stage. A generic national checklist won't hold up here.

This guide is built around the Bay Area's specific code environment. It walks you through every inspection phase, the jurisdictional differences that actually matter, the mistakes that even experienced teams make, and the long-term habits that make your next commercial project run smoother than this one. Read the whole thing before your next pre-construction meeting — you'll thank yourself later.

chart comparing commercial foundation inspection phases and Bay Area city requirements by jurisdiction
Figure 2 — Commercial foundation inspection phases and typical requirement variations across Bay Area jurisdictions.

The Inspection Mistakes Bay Area Commercial Foundation Projects Can't Afford

Most foundation inspection problems aren't caused by bad engineering — they're caused by bad process. The documentation is wrong, the timing is off, or someone assumed another team member had already handled something. These patterns repeat constantly on Bay Area commercial projects, and they're all preventable.

Skipping Pre-Construction Coordination

You need to meet with the building department before you break ground — not to be polite, but because each Bay Area jurisdiction has specific sequencing requirements that aren't always obvious from the permit packet alone. Here's what skipping that meeting costs you:

  • Surprise requirements for special inspections you didn't budget for
  • Confusion about who submits which forms and when
  • Missing the window for a required pre-pour soil observation by a licensed geotechnical engineer
  • Permit holds that push your pour date back by weeks, not days
  • Inspectors who show up without knowing your project, leading to slower sign-offs

Schedule a pre-construction meeting with the building department within 48 hours of permit issuance. Bring your geotechnical report, your structural drawings, and your special inspection program. Do this before you mobilize equipment — it changes the entire trajectory of the project.

Ignoring the Geotechnical Report Timeline

Your geotechnical report isn't just a document you file and forget. Bay Area inspectors — especially in San Francisco and Oakland — treat it as a living reference throughout the project. Common errors that cost teams real money:

  • Ordering the geotech report after foundation design is already finalized — that's backwards
  • Failing to have the geotechnical engineer available for the pre-pour soil observation
  • Not reconciling the geotech's bearing capacity recommendations with the engineer's footing sizes before forming
  • Losing track of which soil borings correspond to which foundation zones on larger commercial sites
  • Assuming the geotech report from a neighboring parcel is close enough — it isn't

The USGS Earthquake Hazards Program provides publicly available seismic hazard and liquefaction data that Bay Area geotechnical engineers routinely reference — and that inspectors expect your team to be familiar with. Know your site's liquefaction potential before the first inspector arrives, not after they ask about it.

For a detailed look at how the permitting sequence feeds into inspection timing, the guide on the commercial foundation permit process in Bay Area cities covers exactly the steps most teams get out of order.

Bay Area Jurisdiction Requirements Side by Side

One of the biggest surprises for contractors new to Bay Area commercial work is how much inspection requirements vary city to city. These aren't minor stylistic differences — they affect your schedule, your special inspection budget, and the paperwork your project manager has to manage throughout the build.

What Each City's Inspectors Focus On

Jurisdiction Pre-Pour Soil Observation Special Inspection Required Rebar Documentation Notable Local Requirements
San Francisco Required — geotech on-site Yes: concrete, rebar, welding Signed inspection cards + date-stamped photos DBI may require pier depth logs on soft soil sites; SFDBI addendum to CBC
San Jose Required on expansive clay and hillside sites Yes: structural concrete and masonry Approved plan set on-site; deviations must be noted in writing Strong focus on seismic anchor bolts, hold-downs, and shear wall connections
Oakland Required — written geotechnical observation letter Yes: includes epoxy-set anchors and high-strength bolting Photos plus inspector signature at each stage Hillside commercial projects require stepped foundation sign-off; active fault setback documentation
Fremont Required near designated liquefaction zones Yes: structural concrete and post-installed anchors Standard IBC requirements apply Engineering observation often required at bearing elevation before forming begins
Santa Clara County (unincorporated) Case-by-case based on soils report Yes: per project type and complexity Standard CBC plus county addendum form Inspection scheduling lead times routinely run 2–3 weeks; plan accordingly

This table covers the broad strokes. Get the specifics from the building department at your pre-construction meeting — every jurisdiction has nuances that aren't captured in the permit packet, and inspectors notice when you're working from outdated information.

Unincorporated County Considerations

Working in unincorporated Santa Clara or Alameda County is a fundamentally different experience from working with city building departments. Here's what actually changes:

  • Inspection scheduling runs through county public works or planning, not a city building desk — expect longer lead times as a baseline
  • Special inspection programs may need county approval before the first structural pour, which is a separate submittal from the permit
  • Engineering observation reports are often required within 24 hours of the observation — confirm the turnaround expectation upfront
  • Never assume the county inspector has seen your full plan set — bring physical copies to every inspection

Budget two to three extra weeks for inspection scheduling in unincorporated zones. This isn't a knock on county efficiency — it's simply how the system operates, and experienced Bay Area contractors build it into their schedule from day one.

Your Phase-by-Phase Commercial Foundation Inspection Checklist Bay Area Projects Require

Here's the core of what you came for. This phase-by-phase breakdown covers the most common commercial foundation types in the Bay Area: spread footings, mat slabs, and drilled piers. Adapt it to your specific project, but don't skip items. Each one exists because someone, somewhere, had a costly problem without it.

Pre-Pour Inspection Items

The pre-pour inspection is the most critical gate on the entire project. Once concrete goes in, you can't see what's underneath. Get every item verified before you call for the pour:

  1. Excavation to bearing elevation confirmed by geotechnical engineer — written observation letter in the job file before anything else happens
  2. Bottom of excavation compacted per geotech specification; proof-roll results documented with date and observer name
  3. Footing dimensions measured against approved structural drawings — measure before forming, not after
  4. Rebar size, spacing, and lap lengths verified against the structural plan set, not the shop drawings alone
  5. Rebar cover meets CBC minimums: 3 inches for footings cast against earth, 1.5 inches for formed concrete above grade
  6. Dowels for wall connections, column piers, and slab edges set at correct locations and embedment depths
  7. Seismic anchor bolts and hold-down hardware positioned, plumb, and within tolerance per plan notes
  8. Conduit sleeves and utility penetrations set before pour — no core-drilling through bearing elements after the fact
  9. Subgrade moisture control in place: vapor barrier lapped and taped, drainage layer thickness confirmed
  10. Certified concrete mix design submittal on-site and reviewed
  11. City or county inspector has reviewed forms and reinforcing — signed inspection card in hand before the first truck arrives

Post-Pour and Structural Readiness

The inspection work doesn't stop after the pour. Here's what needs to happen before framing begins:

  • Concrete compressive strength testing: cylinders broken at 7 and 28 days, results submitted to the special inspector and filed in the job record
  • Anchor bolt survey — verify locations against the framing plan before sill plates are drilled
  • Crack documentation: any crack wider than 1/16 inch needs to be logged, photographed, and evaluated by your structural engineer of record
  • Drilled pier depth logs (if applicable) reviewed, signed by the special inspector, and tied to the site plan with pier ID numbers
  • Final foundation inspection by city or county building department — do not start framing until this card is signed
  • Top-of-concrete elevations surveyed and compared to structural datum — grade beam elevations that are off affect the entire framing package

For projects on expansive Bay Area clay, this post-pour window is also when you should verify your perimeter drainage is performing as designed. Saturation events during the curing period can affect long-term bearing behavior on heavy clay profiles, and catching drainage issues now costs far less than addressing differential settlement later.

New Developer vs. Experienced GC: Where Checklist Priorities Differ

Your experience level on Bay Area commercial foundation projects fundamentally shapes which parts of the checklist need the most deliberate attention. This isn't about competence — it's about where knowledge gaps typically live and how to close them before they become problems.

First-Project Focus Areas

If this is your first commercial foundation project in the Bay Area, put extra effort into understanding these areas before ground breaks:

  • Permit sequencing — your special inspection program must be approved before structural concrete, and many first-timers learn this the hard way mid-project
  • The difference between a city inspection (pass/fail on code compliance) and a special inspection (ongoing third-party quality verification) — they're not interchangeable and they don't replace each other
  • Identifying which items on your structural drawings have plan notes that trigger additional inspection or observation requirements beyond what's standard
  • Knowing that geotechnical engineers bill per site visit, not per project — budget for multiple observations, especially on complex sites
  • Local concrete suppliers and their certified mix designs, since inspectors will ask for the mix submittal at the pre-pour meeting

Before you finalize your project budget, review the cost breakdown for small commercial building foundations in the Bay Area — inspection-related line items like special inspection programs, geotech observation fees, and testing lab services are routinely underestimated by first-time developers, sometimes by 30 to 50 percent.

What Veteran Teams Handle Automatically

Experienced Bay Area commercial contractors have built these habits into their workflow without having to think about them. If you're building your process from scratch, add these explicitly to your checklist system — don't assume they'll happen on their own:

  • Pre-scheduling inspections five to seven business days out — Bay Area building departments routinely don't have next-day availability, and assuming they do will cost you pours
  • Maintaining a standing relationship with a certified special inspection firm that already knows the local jurisdictions' quirks and form requirements
  • Keeping a digital job file with photos and signed inspection cards updated in real time, not reconstructed at the end of the week
  • Running a weekly RFI log during foundation work so no structural question goes unresolved before it affects a pour or an inspection
  • Having a concrete testing lab on retainer before mobilization, not scrambling to find one at the pre-pour meeting
  • Confirming inspection requirements with the building department directly even when you're confident — jurisdictions update their processes, and last project's workflow may not apply to this one

The gap between a first-timer and an experienced team on inspection management isn't knowledge — it's systems. Build the systems early and you won't have to improvise when it matters.

When the Inspector Raises a Flag: How to Respond Without Losing Your Schedule

Getting a correction notice isn't a catastrophe — it's a normal part of commercial foundation work in the Bay Area. What matters is how fast and how clearly you respond. Panic, argue, or go silent, and you'll lose weeks. Move methodically, and you can often resolve corrections without missing your pour window.

Common Correction Notices Explained

Here are the most common flags Bay Area inspectors issue on commercial foundation projects, and what each one actually means for your next steps:

  • Rebar cover deficiency — Concrete cover to reinforcing steel doesn't meet CBC minimums. You'll need to reposition rebar or revise form dimensions. Straightforward fix if caught pre-pour; extremely expensive if caught post-pour.
  • Bearing elevation not confirmed — The inspector wants a written geotechnical observation letter before signing off. Contact your geotech immediately, schedule the site visit, and get the letter delivered same day if possible.
  • Anchor bolt location out of tolerance — Bolts are outside the allowable positional tolerance from the plan location. Options: reposition bolts before pour, get a structural engineer to evaluate and approve the as-built deviation, or revise the framing plan to accommodate the actual position.
  • Special inspection program not on file — Administrative issue: the building department doesn't have a copy on-site. Deliver a physical copy and get it date-stamped and logged before the next inspection attempt.
  • Concrete mix submittal missing — You need the certified mix design from your concrete supplier on-site before the pour. Call the supplier directly — this is a supplier documentation issue, not an engineering issue.
  • Inadequate subgrade compaction — The inspector or geotechnical engineer is not satisfied with the bearing surface. You'll need additional compaction, retesting, and a written geotechnical clearance before forming can continue.

Requesting a Re-Inspection

After addressing a correction notice, here's the cleanest path to a successful re-inspection:

  1. Document your correction in writing: photos with date stamps, updated inspection log entries, and any revised drawings or engineering letters
  2. Contact the building department directly — by phone, not only through the permit portal — to schedule the re-inspection and confirm availability
  3. Stage all documentation physically on-site before the inspector arrives, not just in your email or phone
  4. If the correction involved any structural deviation, get written engineer approval before the re-inspection — presenting it during the visit reads as improvised and creates doubt
  5. Brief the inspector clearly at the start of the visit on exactly what was corrected and where — don't make them hunt for the change

Most correction notices on Bay Area commercial foundation projects are resolved within two to five business days when handled this way. The ones that drag on for weeks are almost always documentation problems, not field problems. Clean documentation is the fastest path through any re-inspection.

When to Bring In a Third-Party Inspector (And When to Skip It)

Third-party or special inspection isn't optional on most Bay Area commercial foundation projects. CBC Chapter 17 and local amendments require it for structural concrete, reinforcing steel, and high-strength bolting above certain thresholds. But there's a gray area for smaller projects where the decision involves real judgment — and getting it wrong costs you in either budget or quality.

Projects That Always Warrant Independent Review

Don't debate it on these project types. Get a certified special inspector in place before you start any structural foundation work:

  • Any commercial building three stories or taller — the code is unambiguous here
  • Projects with drilled pier or caisson foundations, especially on Bay Area expansive clay or near active fault setback zones
  • Mat slab foundations supporting heavy equipment, industrial loads, or post-tensioned systems
  • Sites within a designated liquefaction zone — common in parts of Oakland, Fremont, and the South Bay near the bay margins
  • Any project where the structural engineer of record has specified special inspection in plan notes — this is a contract and code requirement, not a suggestion you can negotiate around
  • Projects using high-strength concrete (f'c greater than 5,000 psi) or specialty admixtures that affect curing behavior

Scenarios Where Your GC Can Cover It

There are limited situations on smaller commercial projects where your general contractor and the city's building inspector together provide adequate oversight. Be honest about which bucket your project actually falls into:

  • Small commercial tenant improvements with no structural foundation work — only slab patching or surface repair
  • Single-story accessory structures under roughly 600 square feet on stable soil conditions, with no special inspections noted anywhere on the approved plan set
  • Minor foundation repairs on existing commercial buildings — though work involving drilled piers or epoxy-set anchors on Bay Area clay almost always warrants a special inspector regardless of project scale

When in doubt, hire the third-party inspector. The cost is always less than the schedule impact of a correction notice at pour stage — and far less than a structural deficiency discovered post-occupancy, which triggers a different kind of conversation entirely.

Building a Long-Term Commercial Foundation Compliance Strategy in the Bay Area

If you're planning more than one commercial project in the Bay Area, treat inspection compliance as an ongoing system, not a per-project scramble. The contractors who consistently hit their pour schedules without surprise holds are the ones who've built repeatable processes and invested in relationships that pay forward.

Documentation Systems That Pay Off

The best documentation system is the one your whole team actually uses. Here's what works on Bay Area commercial foundation projects in practice:

  • Dedicated digital project folder at permit issuance with subfolders for: geotech report, structural drawings, permit set, special inspection program, inspection cards (scanned), concrete test results, engineering letters, and daily photo logs
  • Date-stamped, location-tagged daily photo log at every inspection stage — backed up off the job site, not just on someone's phone
  • Inspection tracking sheet: one row per required inspection, with date scheduled, date completed, inspector name, pass/fail, and any open items
  • Concrete pour log: mix design number, truck ticket numbers, slump test results at each truck, cylinder break schedule, testing lab contact
  • RFI log maintained throughout foundation work — every unresolved structural question documented with date submitted and date answered

Build this folder structure the day you pull the permit, not when the inspector asks for documentation. You won't have time to organize it under pressure, and disorganized job files are a red flag that experienced inspectors notice immediately.

Inspector Relationships Matter More Than You Think

Bay Area building inspectors are professionals doing a demanding job under real scheduling pressure. The contractors who get the fastest re-inspection turnarounds and the fewest surprise correction notices are not the ones who push back hardest — they're the ones who make the inspector's job easier every single visit.

  • Call ahead when scheduling inspections, even when you can also submit online — a brief phone call creates a human connection that an online ticket doesn't
  • Stage your documentation accessibly before the inspector arrives — don't make them wait while you dig through a truck cab or scroll through your phone
  • If you need to deviate from the approved plans, get engineering authorization before the inspection, not during it — presenting surprise changes puts inspectors in an uncomfortable position and usually results in a hold
  • Follow up after each passed inspection with a written summary of what was approved and any outstanding items you're tracking

This is a long-game approach. Your reputation with local Bay Area building departments compounds over years of projects. Contractors who are consistently easy to work with earn more scheduling flexibility — and in Bay Area commercial construction, that flexibility translates directly to dollars saved on carry costs and schedule compression.

Frequently Asked Questions

How many inspections are typically required for a commercial foundation in the Bay Area?

Most commercial foundation projects in the Bay Area require a minimum of three to five building department inspections: pre-pour (reinforcing and forms), concrete pour (sometimes observed by special inspector), post-pour (before backfill or framing), and a final foundation inspection. Projects with drilled piers, post-tensioned slabs, or complex soil conditions often require additional engineering observations on top of the standard city or county inspections. Your special inspection program will spell out the full inspection sequence for your specific project.

What is a special inspection program and when is it required?

A special inspection program is a formal document — typically prepared by the structural engineer of record and approved by the building department — that outlines which materials and work items require independent third-party inspection during construction. In the Bay Area, it's required by CBC Chapter 17 for structural concrete, reinforcing steel, high-strength bolting, welding, and several other work types on commercial projects. You need the program approved before any special-inspection-listed work begins, not afterward. Submit it with your permit application whenever possible.

How long does a typical commercial foundation inspection take in Bay Area cities?

The inspection itself usually takes 30 to 90 minutes depending on project complexity. The harder variable is scheduling: San Francisco, San Jose, and Oakland building departments typically need three to seven business days advance notice for commercial foundation inspections. Unincorporated county zones can run two to three weeks. Never assume next-day availability on a Bay Area commercial project — build inspection scheduling lead time into your pour schedule from the start of the job.

What happens if my commercial foundation fails a Bay Area inspection?

A failed inspection results in a correction notice listing the specific deficiencies that need to be addressed before work can continue. You don't automatically lose your permit — but you cannot proceed with the next phase of work until the corrections are documented, completed, and a re-inspection is passed. Address the deficiencies promptly, document everything in writing, and contact the building department to schedule the re-inspection. Don't start framing or proceed with subsequent work while a failed foundation inspection is open — doing so creates compounding code violations.

Do I need a geotechnical engineer on-site for every Bay Area commercial foundation inspection?

Not for every inspection — but you do need a geotechnical engineer present for the pre-pour soil observation in most Bay Area jurisdictions, and a written observation letter from the geotech is typically required before the city or county inspector will sign off on the pre-pour inspection card. For drilled pier projects, the geotech is usually required to observe and log pier depths during drilling. For standard spread footing projects on stable sites, the geotech's written bearing elevation confirmation is typically sufficient without continuous on-site presence throughout forming.

Key Takeaways

  • A phase-by-phase commercial foundation inspection checklist Bay Area teams use consistently prevents the documentation gaps that cause last-minute pour delays and correction notices.
  • Bay Area jurisdictions — San Francisco, San Jose, Oakland, and unincorporated county zones — have meaningfully different inspection requirements, and a pre-construction meeting with the building department is non-negotiable on every commercial project.
  • Special inspection programs must be approved before structural work begins, geotechnical observation letters must be in the job file before the pre-pour sign-off, and re-inspections are won or lost on documentation quality, not fieldwork alone.
  • Contractors who build repeatable documentation systems, pre-schedule inspections early, and maintain professional relationships with local inspectors consistently outperform those who approach each project from scratch.
