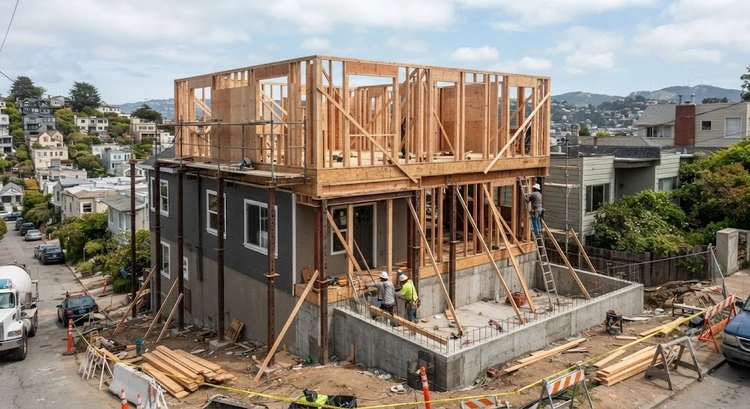

Second-story addition foundation requirements in the Bay Area are stricter than most people realize — and for good reason. Before any framing crew starts stacking walls, the existing foundation needs a full structural evaluation. Our team specializes in addition room foundations across the Bay Area, and what we see consistently is that skipping this step is the number-one reason second-story projects stall at the permit stage. The good news: once the evaluation is done, the path forward is usually clear.
Adding a second floor roughly doubles the dead load (constant structural weight) on the existing foundation. Bay Area homes also sit in high seismic zones, which means the foundation must handle lateral forces — the sideways push during an earthquake — that a typical single-story footing was never designed for. That's two major demands landing on one aging concrete structure at the same time. Our team always approaches these projects with both challenges in mind from the start.
Soil conditions add another layer of complexity. Many Bay Area neighborhoods sit on expansive clay or soft alluvial deposits that compress and shift under increased loads. Our team always looks at soil conditions alongside the structural math. Understanding how Bay Area soil conditions affect room addition foundation design is essential before anyone finalizes a second-story plan — because no amount of concrete work fixes a bad soil situation if the soil hasn't been accounted for.
Contents
- Why Second-Story Additions Put Bay Area Foundations to the Test
- How We Evaluate an Existing Foundation for a Second Story
- Foundation Scenarios That Shape What Work Gets Done
- Foundation Upgrade Options Compared
- What We've Seen on Real Bay Area Projects
- Foundation Scope: Simple vs. Complex Second-Story Additions
- Common Problems During Second-Story Foundation Reviews
Why Second-Story Additions Put Bay Area Foundations to the Test
The Seismic Factor
The Bay Area sits in one of the most seismically active regions in the country. California's Seismic Hazard Mapping program identifies large portions of the Bay Area as high-hazard zones — and those designations directly shape what the California Building Code requires for foundation design. A second story raises a building's center of gravity, which increases the overturning moment (the tendency for a building to tip sideways) during a quake. The foundation now has to resist more force than it was originally sized for.
Our team sees this play out in the permit review process on almost every second-story project. Structural engineers calculate the new seismic loads, compare them against the existing foundation's documented capacity, and identify what needs to change. In our experience, some level of seismic upgrade is required on the vast majority of Bay Area second-story additions — whether that means new anchor bolts, shear walls, or something more involved. The question is rarely whether seismic work is needed, but how much.
Aging Foundations and Code Upgrades
Most Bay Area homes were built before modern seismic standards took effect. Homes from the 1950s through the 1980s often have unreinforced concrete perimeter foundations — no rebar inside the concrete — and minimal anchor bolting connecting the wood framing to the foundation. Those foundations were acceptable under the codes that existed when the house was built. They don't meet today's standard for supporting a second-story load.
When a permit is pulled for a second-story addition, the local building department typically requires the foundation to be brought up to current code — not just evaluated against the old standard it was built to. That's a detail that catches many people off guard during budgeting. Our team always recommends reviewing whether signs of existing foundation problems are already present before starting the second-story permitting process, since any pre-existing issues get folded into the same scope of work.

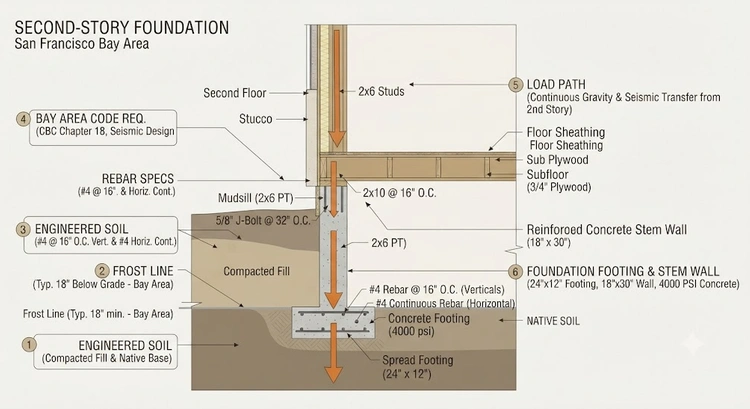

How We Evaluate an Existing Foundation for a Second Story
The Structural Engineering Report
Step one is hiring a licensed structural engineer. This isn't optional — Bay Area building departments require a stamped structural report for any second-story addition permit application. The engineer will typically:
- Review original building plans if they're available, or perform a full field survey if they're not
- Measure existing footing dimensions and depth by exposing test sections in select locations
- Inspect for rebar and anchor bolts, sometimes using ground-penetrating radar on inaccessible areas
- Calculate dead loads (structural weight), live loads (people and furnishings), and seismic loads for the proposed second story
- Issue a stamped report stating what the existing foundation can support and what specific upgrades are required
This process typically takes two to four weeks from the site visit to the final stamped report. Our team works closely with structural engineers throughout these evaluations. Getting this step done before finalizing a design or budget is the single most important thing anyone can do — because it defines what the project actually costs.
The Soil Report
In many Bay Area cities, a geotechnical (soil) report is required for second-story additions — especially on properties with steep slopes, soft soils, or locations near known liquefaction zones. The soil report establishes the bearing capacity (how much weight the soil can safely support per square foot) that the structural engineer uses in their foundation calculations. Without that number, the structural calculations are built on assumptions rather than facts.
Our team's position on this is firm: the soil report is not a bureaucratic formality. A foundation that looks solid above ground can be sitting on material that compresses or shifts under a doubled load. Understanding what a soil report tells a foundation engineer is one of the most important pieces of the whole second-story evaluation puzzle — and skipping it creates risk that shows up later in the worst possible way.
Never skip the geotechnical report on a second-story addition — a foundation can look perfect above ground and still be sitting on soil that won't support the additional weight safely.
Foundation Scenarios That Shape What Work Gets Done
Houses That Often Pass With Minimal Work
Not every Bay Area home needs a major foundation overhaul before a second story goes up. Some situations where existing foundations tend to hold up reasonably well under engineering review:
- Post-1980 homes built to modern seismic codes with existing rebar and proper anchor bolting
- Homes on stable, well-drained soils with adequate bearing capacity confirmed by testing
- Partial second-story additions covering only a portion of the first-floor footprint
- Homes that have already undergone a full seismic retrofit, since that work overlaps significantly with second-story requirements
Even in these favorable scenarios, engineering review and permit documentation is still required. "Minimal work" doesn't mean no work — it means the foundation changes are smaller in scope and less disruptive. Our team still insists on getting the structural report completed before assuming any project falls into this category.
Houses That Usually Need Significant Upgrades
These situations almost always trigger more substantial foundation work when second-story addition foundation requirements in the Bay Area are applied:
- Pre-1970 homes with unreinforced concrete foundations and no rebar
- Homes sitting on expansive clay soils — a very common condition in Oakland, Fremont, San Jose, Milpitas, and much of the East Bay
- Properties in designated liquefaction or landslide hazard zones
- Full second-story additions covering the entire first-floor footprint, which maximize the additional load
- Homes with visible foundation cracking, sticking doors, or differential settlement (uneven sinking across the structure)
In these situations, heavier engineering intervention is the norm. Our team always leads with the structural and soil evaluation so the budget is built on real data. A guess-based budget on a complex Bay Area second-story addition almost always ends in cost overruns or permit delays.
Foundation Upgrade Options Compared
Underpinning vs. Perimeter Footing Widening
When the existing foundation is inadequate for a second story, there are several upgrade paths. The right approach depends on soil type, existing footing size, the structural engineer's load calculations, and access conditions on the specific site.
| Upgrade Type | What It Does | Best For | Approximate Cost Range (Bay Area) |
|---|---|---|---|
| Underpinning (mass concrete or micropiles) | Extends foundation depth to reach stronger soil or bedrock below | Soft soils, poor near-surface bearing capacity | $15,000–$50,000+ |
| Perimeter footing widening | Pours new concrete alongside existing footings to increase bearing area | Undersized footings on stable, adequate soil | $8,000–$25,000 |
| Anchor bolt upgrade | Installs new anchor bolts to properly secure sill plate to foundation | Missing or insufficient existing anchor bolting | $3,000–$8,000 |
| Shear wall addition | Adds structural plywood panels to resist lateral seismic forces | Seismic load deficiencies at first-floor walls | $5,000–$20,000 |
| Full foundation replacement | Demolishes and repours the entire perimeter foundation | Severely deteriorated or fundamentally undersized foundation | $40,000–$100,000+ |
These ranges reflect Bay Area labor and material costs, which run consistently higher than national averages. Final cost depends heavily on site access, soil conditions, the size of the footprint, and how much temporary shoring (support structure) is needed while the foundation work is underway.
Adding Shear Walls for Lateral Loads
Shear walls deserve separate attention in any second-story addition. Even when the vertical load capacity checks out fine, the lateral (sideways) forces from seismic activity often require a new shear wall system at the first-floor level. Shear walls connect through the floor system down to the foundation through hardware called hold-downs — and those connections have to be precisely engineered and installed. This is where the foundation contractor and structural engineer have to coordinate tightly, because a shear wall that isn't properly tied to the foundation doesn't do its job in a quake.
Our team has completed projects where the vertical foundation work was relatively minor, but the shear wall and hold-down work drove most of the cost. Anyone planning a second-story addition in the Bay Area should budget for both pieces independently before assuming one or the other is a minor line item.
What We've Seen on Real Bay Area Projects
A San Jose Ranch-Style Home
Our team worked on a 1962 ranch-style home in San Jose where the owners wanted to add a full second story over the entire footprint. The existing foundation was an unreinforced concrete perimeter footing — no rebar, shallow depth, and footings that were too narrow by current standards. The soil report showed moderate bearing capacity, which was good, but the structural deficiencies in the foundation itself were clear.
The solution: perimeter footing widening on three sides, a complete anchor bolt upgrade, and new shear wall panels at the garage opening where the existing wall had no lateral resistance. The permit process went through the San Jose building department and followed the standard requirements covered in detail for room addition foundation permits in San Jose. Total foundation scope ran approximately $31,000 before a single framing member went up. The project moved forward cleanly once that work was done and inspected.
An Oakland Hills Craftsman
An Oakland Hills Craftsman from 1928 was a more involved situation. Steep hillside lot, confirmed expansive clay soil from the geotechnical report, and a raised foundation (a foundation type where a crawl space exists below the first floor) with concrete piers in varying condition. The structural engineer required underpinning on the downhill side, replacement of two deteriorated piers, and a full shear wall system at the cripple wall (the short wood-framed wall that sits between the concrete foundation and the first-floor framing).
The owners had considered a seismic retrofit earlier but hadn't committed to it. Our team pointed out that the second-story foundation work would accomplish most of what a retrofit would have done — and understanding seismic retrofit costs in context helped the owners see the second-story foundation investment as doing double duty. Total foundation scope on this Oakland project: $56,000. Significant, but unavoidable given the site conditions and the age of the structure.
Foundation Scope: Simple vs. Complex Second-Story Additions
Straightforward Projects
Some second-story addition foundation scopes are genuinely manageable. These tend to share a few characteristics that make the engineering review go more smoothly:
- Post-1980 construction with existing seismic upgrades already documented
- Flat lots with good, stable soil conditions confirmed by testing
- Partial second-story additions covering only one wing or over an attached garage
- Homes already on solid perimeter foundations with visible, adequate rebar and proper anchor spacing
In these cases, the foundation work might be limited to adding new anchor bolts in a few locations, installing one or two shear wall panels, and documenting the existing footing dimensions for the permit engineer's calculations. Our team has completed second-story foundation scopes in this category for as little as $10,000–$15,000. These are the projects where good pre-construction evaluation really pays off — knowing early that the scope is small lets the entire project budget and schedule come together cleanly.
Projects With Multiple Challenges
Complex projects stack multiple challenges simultaneously. A steep slope combined with soft soil and pre-1960 construction is the kind of combination that routinely drives foundation scopes into six-figure territory. Our team's approach on complex projects:
- Commission both the structural report and soil report before any architectural design is finalized — the reports define what's possible, not the other way around
- Request a pre-application review from the local building department to understand their specific documentation requirements before formal submittal
- Plan for foundation work to take four to eight weeks before any framing can begin
- Build a 15–20% contingency into the foundation budget, because excavation routinely reveals conditions that weren't visible during pre-construction evaluation
Properly connecting all new foundation work to the existing structure is a discipline in itself. Our team's in-depth breakdown of how to tie room addition footings into an existing foundation covers the specific technical requirements for that connection — and it's required reading for anyone managing or self-contracting a Bay Area second-story addition.
Common Problems During Second-Story Foundation Reviews
Permit Delays
The most common delay our team sees: the structural documentation doesn't align with what the specific building department requires at submittal. Bay Area cities each have their own interpretation nuances within the California Building Code for residential additions. San Jose, Oakland, Fremont, and San Francisco all run different plan check timelines and may request different supplemental documentation during review.
Our recommendation is straightforward: submit complete, fully stamped plans with both the structural and soil reports included from day one. Incomplete submittals that come back for corrections routinely add three to six weeks to the review cycle. Every week of permit delay pushes the project's start date — and in the Bay Area, contractor schedules book out fast. Getting the documentation right the first time is not just a bureaucratic detail, it's a scheduling strategy.
Surprises Found During Demo
Even with thorough pre-construction evaluation, demolition and excavation sometimes expose conditions that weren't detectable beforehand. The most common surprises our team encounters:
- Hidden water damage in the sill plate (the wood member that sits on top of the foundation) or the rim joist (the horizontal framing around the floor perimeter), often from years of undetected moisture
- Footings that are shallower than original drawings indicate — very common in older homes where as-built conditions diverged from plans
- Post-and-pier foundations in worse condition than they appeared during the crawl space inspection
- Previous un-permitted "repairs" that don't meet current standards and have to be removed before compliant work can be installed
Our team builds field-condition allowances into every second-story foundation contract. Defining in advance how common surprises will be handled — with clear scope and cost structures for the most likely scenarios — keeps the project moving when something unexpected comes up during excavation. Stopping the project to renegotiate every discovery adds weeks and creates friction that's entirely avoidable.
A second story asks more of a foundation than it was ever designed to give — find out what's actually there before committing to what goes on top of it.
