Which foundation type will actually hold your room addition for decades — and which one might let you down the first time Bay Area clay shifts beneath it? If you're weighing the continuous footing vs pier foundation room addition question, you're already ahead of most homeowners who approve drawings without understanding what's in them. The right answer depends on your soil, your framing approach, and your local building code. Our room addition foundation work across the Bay Area shows a clear pattern: three factors drive this decision every time — soil bearing capacity, load distribution, and seismic performance.

Continuous footing vs isolated pier foundation options for a room addition in the Bay Area

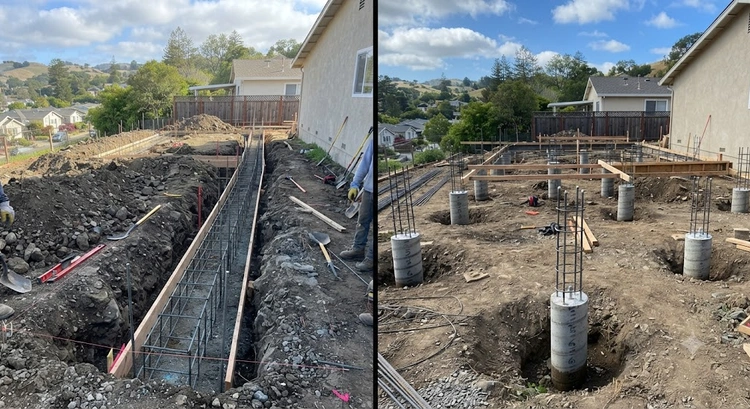

Figure 1 — Continuous footing runs beneath every load-bearing wall (left); isolated piers carry point loads at individual post locations (right).

A continuous footing (also called a strip footing) is a concrete beam that runs under every load-bearing wall of your addition. It spreads weight evenly along an unbroken line. An isolated pier (also called a spread footing or point footing) is a standalone concrete column or pad that carries load from a single post or column. Both systems are code-compliant when properly engineered. They are not, however, interchangeable.

Getting this decision wrong has real consequences. Under-engineered foundations crack and settle unevenly. Over-engineered ones drain your budget without adding anything useful. Room addition foundation costs in the Bay Area can swing dramatically based on exactly this kind of design call. This guide gives you what you need to have a real conversation with your engineer before anyone breaks ground.

Two Foundation Systems, Explained Simply

Before comparing options, you need a clear picture of what each system does underground. Most homeowners assume a foundation is just "concrete under the house." It's more specific than that — and the difference matters for how your addition performs over decades.

Continuous Footing Basics

A continuous footing runs like a concrete ribbon beneath every load-bearing wall of your addition. It distributes your structure's weight across a long, unbroken contact line with the soil below. Key characteristics:

  • Typically 12–24 inches wide and 12–18 inches deep in frost-free Bay Area conditions
  • Reinforced with rebar (steel bars) running lengthwise and crosswise
  • Ties into a stem wall — a short concrete wall that rises above grade to meet your floor framing
  • Required under all load-bearing walls in most standard wood-frame room additions

Continuous footings are the default for most wood-frame additions. They perform best on stable, uniform soil and satisfy residential building codes with relatively straightforward engineering drawings.

Isolated Pier Basics

An isolated pier is a standalone concrete pad or column. It carries load from a single post or column above it — not an entire wall. Typical characteristics:

  • Square or round in plan, often 18×18 inches to 24×24 inches or larger depending on load
  • Typically deeper than continuous footings when placed on expansive or soft soil
  • Common in post-and-beam framing systems where posts carry the load, not walls
  • Useful where continuous excavation isn't practical — steep slopes, limited access, or rocky subsoil

According to Wikipedia's overview of foundation engineering, isolated footings are among the most common shallow foundation types worldwide when column loads are manageable and soil bearing capacity is adequate.

How Engineers Decide Between Them

This isn't a homeowner preference call — it's an engineering judgment. But knowing what your engineer evaluates helps you ask better questions and understand the drawings before you sign off on them.

Soil Type and Structural Load

Soil is always the starting point. Bay Area soil conditions affecting room addition foundation design vary dramatically — dense sand in some East Bay pockets, soft bay mud near the water, expansive clay in inland valleys. Your engineer evaluates:

  • Bearing capacity — the pounds per square foot the soil can carry without compressing and settling
  • Soil uniformity — variable or patchy soil often benefits from continuous footing to bridge weak spots
  • Expansive clay content — clay swells and shrinks with moisture, which can shift isolated piers unpredictably over time
  • Slope — steep lots often favor isolated piers with deeper embedment for hillside stability

A one-story addition on flat, stable ground almost always gets continuous footing. Post-and-beam framing on a hillside often gets isolated piers. On sloped sites, understand how stepped foundations for room additions on sloped Bay Area lots interact with both systems before locking in your design.

Seismic Code Considerations

The Bay Area sits in one of the most seismically active zones in North America. That shapes foundation design at every level. Continuous footings offer more inherent lateral resistance — resistance to the sideways forces earthquakes generate — because they form a rigid perimeter tied together under the walls. Isolated piers can be engineered for seismic performance, but they typically require hold-down hardware (metal connectors anchoring each post to its concrete base) and may need a grade beam (a concrete beam at ground level connecting the piers) to satisfy current code requirements.

Pro tip: Always confirm with your structural engineer whether isolated piers require a connecting grade beam before your design is finalized — missing this detail often means costly redesigns after permits are already submitted.

How Each Foundation Gets Built

Understanding the installation sequence helps you manage your project timeline and catch problems before they become expensive. The two systems follow different paths from layout to final pour.

Continuous Footing Installation

Here is the typical sequence for a continuous footing on a room addition:

  1. Layout and excavation — stakes and strings mark the wall perimeter; a mini-excavator digs a continuous trench to the required depth (typically 18 inches minimum below finish grade in Bay Area conditions)
  2. Forming — wood or metal forms hold the concrete shape; anchor bolts (J-bolts the sill plate attaches to) are positioned at code-required spacing
  3. Rebar placement — horizontal and vertical steel goes in per the engineer's drawings; a building inspector must approve this before any concrete is placed
  4. Concrete pour — typically a 2,500–3,000 psi (pounds per square inch) mix placed in one continuous operation to avoid cold joints (weak seams between separate pours)
  5. Cure and strip — forms come off in 24–48 hours; concrete reaches full design strength at 28 days

From excavation to ready-to-frame typically takes 5–10 business days, depending on inspection scheduling. For the permit side of this process, the Bay Area foundation permit process guide walks through every step.

Isolated Pier Installation

Pier installation follows a different sequence:

  1. Spot excavation — individual holes drilled at each post location, often with a power auger (a large drill attachment for soil)
  2. Depth verification — an engineer or special inspector confirms each hole has reached adequate bearing soil before forming begins
  3. Form and rebar cage — tube forms or formed holes receive a rebar cage sized per the structural drawings
  4. Individual pours — each pier poured separately; post bases or anchor hardware set while concrete is still workable
  5. Grade beam (if required) — a connecting concrete beam between piers may be poured after individual piers cure, to satisfy seismic requirements

Pier installation can be faster per unit on simple sites. But tight side yards, steep slopes, and grade beam requirements add time and cost that aren't always obvious upfront.

What Each System Actually Costs

Cost is where the continuous footing vs pier foundation room addition decision hits closest to home for most people. Neither system is universally cheaper — your site conditions and framing system determine which comes out ahead on your specific project.

Cost Comparison at a Glance

Cost Factor Continuous Footing Isolated Pier
Excavation Continuous trench — more soil removed and hauled Spot holes — less soil volume per location
Concrete volume Higher — fills entire trench length Lower per pier; higher if grade beam is required
Forming labor Moderate — consistent, repetitive process Moderate to high — multiple setups, hardware placement
Engineering fees Standard for residential addition Often higher — seismic detailing, grade beam design
Typical Bay Area range (200 sq ft addition) $8,000–$18,000 $7,000–$22,000+

Hidden Costs to Watch

A few line items consistently surprise homeowners on both system types:

  • Soil export fees — Bay Area disposal costs for excavated material can add $500–$2,500 depending on volume and classification
  • Grade beam additions — if isolated piers need a connecting beam, that's material, forming, and separate pour labor you didn't budget for
  • Soil report — required by most Bay Area jurisdictions; typically $1,500–$3,500 before any engineering begins
  • Re-inspection fees — if work isn't ready when the inspector arrives, you pay for a return visit
  • Utility relocation — underground lines discovered during excavation add time and cost to either system

Insider Tips Before You Break Ground

Experienced contractors know things about this process that homeowners rarely hear until something goes wrong. A few of the most valuable observations from Bay Area job sites:

Start with a Soil Report

Don't hire a structural engineer until you have a soil report in hand. The report tells your engineer what's below grade — bearing capacity, clay content, groundwater depth, and liquefaction risk (the risk that saturated soil behaves like liquid during a major earthquake). What a soil report tells your foundation engineer is worth reading before you set any project budget.

A common and expensive mistake: choosing a foundation type based on a neighbor's project or a contractor's preference before you've seen soil data. Soil profiles can change dramatically within a single city block. Your neighbor's successful pier system might be completely wrong for your lot.

Permit and Inspection Tips

  • File for permits early — Bay Area building departments often carry 4–12 week plan-check backlogs
  • Schedule your pre-pour rebar inspection the day before you plan to pour — inspectors often cannot accommodate same-day requests
  • Keep a copy of approved structural drawings on-site at all times; inspectors check them at every visit
  • Never place concrete before the reinforcement inspection is signed off — you could be required to demolish and rebuild at your own expense
  • Ask your building department whether special inspections (third-party concrete testing) are required — some Bay Area jurisdictions mandate them for additions above a certain size

One more thing worth confirming early: if you're adding onto a home with an existing foundation, your engineer must verify the existing footing can carry the added load. If it can't, foundation underpinning may be needed to extend or strengthen what's already there before the addition framing begins.

Common Problems and How to Catch Them

Most foundation failures aren't sudden events. They're slow-moving problems that surface as wall cracks, sticking doors, or sloping floors years after construction. Both systems have well-documented failure modes that are worth knowing upfront.

Continuous Footing Failure Modes

  • Differential settlement — one section of footing sinks more than adjacent sections, typically due to variable soil density or inadequate compaction before concrete was placed
  • Shrinkage cracks — small hairline cracks are normal in curing concrete; cracks wider than 1/4 inch indicate a structural concern
  • Lateral sliding on sloped sites — footings on hillsides need proper drainage and solid soil engagement to resist downhill creep
  • Rebar corrosion — insufficient concrete cover allows moisture to reach steel; rust expands and fractures surrounding concrete over time

Bay Area expansive clay drives a disproportionate share of continuous footing problems. When clay absorbs winter rainfall and desiccates in summer, it exerts enormous lateral pressure on concrete. Learn how expansive clay soil damages Bay Area home foundations before assuming your soil is stable enough to skip a geotechnical investigation.

Isolated Pier Failure Modes

  • Uplift failure — earthquake forces can pull a pier upward if hold-down hardware is missing, undersized, or improperly embedded
  • Individual pier settlement — when one pier sinks faster than its neighbors, the floor above it tilts noticeably
  • Grade beam cracking — a connecting beam undersized for seasonal soil movement can fail under clay pressure without visible warning
  • Post-base corrosion — hardware embedded at grade is especially vulnerable in coastal or high-moisture Bay Area microclimates

Planning a Foundation That Lasts

Your room addition foundation will almost certainly outlast two or three rounds of kitchen and bath renovations. The decisions you make now affect your future expansion options, your resale value, and your long-term maintenance picture.

Building for Future Expansion

If you might ever add a second story above your addition, say so during the initial engineering phase. A ground-floor addition designed for one story uses different footing dimensions than one engineered to carry future vertical load. Retrofitting an undersized footing after the fact typically costs far more than sizing it correctly from the start. Tell your engineer your long-term plans and let that information shape the foundation design from day one.

Isolated piers require particular attention here. Each pier must be sized for the full eventual load — not just the immediate single-story weight sitting on it today. Under-sizing now creates expensive intervention later, including potential underpinning or full replacement.

Resale and Inspection Considerations

Buyers and their inspectors look closely at additions. A permitted, engineered foundation with a complete inspection record is a tangible selling point. An unpermitted addition — or one showing visible settlement cracks — is a liability that can derail a sale or force a steep price reduction. Protect your investment with a few consistent habits:

  • Keep all permits, approved plans, and inspection records permanently — store them with your property documents, not in a drawer you'll lose track of
  • Get a final letter from your structural engineer confirming the foundation was built per the approved plan
  • Inspect for cracks at the five-year mark and seal any that have developed before they widen further
  • Maintain positive drainage around the addition perimeter — standing water accelerates footing deterioration in both systems
Comparison diagram showing continuous footing vs isolated pier foundation cross-sections for a room addition

Figure 2 — Cross-section comparison: continuous footing soil contact line vs isolated pier depth and rebar cage configuration.

Frequently Asked Questions

Can I use isolated piers instead of continuous footing to save money on a room addition?

Sometimes, but not always. Isolated piers can reduce excavation and concrete volume on stable soil with a post-and-beam framing system. On expansive clay or in high seismic zones, the added engineering requirements — grade beams, hold-down hardware, deeper embedment — can make piers more expensive overall than continuous footing. Get a soil report and a structural engineer's recommendation before making this decision based on cost alone.

Do I need a soil report before choosing between continuous footing and a pier foundation?

In most Bay Area jurisdictions, yes. Your building department will require a soils investigation for any room addition above a certain size, and your structural engineer needs that data to size either foundation type correctly. Skipping the soil report and guessing at foundation design is one of the most common causes of settlement problems and failed inspections in the Bay Area.

Which foundation type performs better in an earthquake — continuous footing or isolated piers?

Continuous footing generally provides better inherent lateral resistance because it forms a rigid perimeter under your load-bearing walls. Isolated piers can perform well seismically when they're correctly engineered — with proper hold-down hardware, a grade beam connecting the piers, and seismic detailing at each post base. Neither system fails automatically in an earthquake when it's designed and built to current Bay Area seismic code.

Final Thoughts

The continuous footing vs pier foundation room addition decision isn't something to settle over a quick phone call or a single contractor's preference. It's an engineering judgment that turns on your specific soil, your framing system, your site conditions, and your long-term plans. If you're ready to get a clear, site-specific answer, contact Pro Home Foundation to schedule a consultation — we'll assess your lot, review your plans, and give you a straightforward recommendation grounded in decades of Bay Area foundation work.
