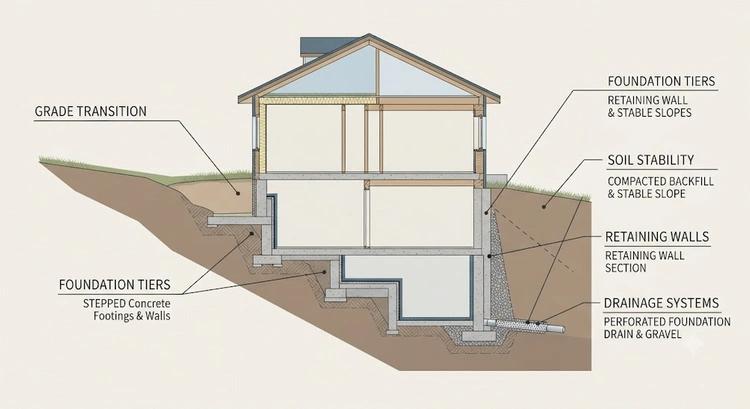

More than 60 percent of residential lots in the East Bay and South Bay carry measurable grade changes — and many exceed a 10 percent slope. On those sites, a stepped foundation for a room addition on a sloped lot is not a compromise: it is the structurally correct answer. Flat slabs and continuous footings poured at a single depth lose soil contact on steep terrain and create unsupported spans. Stepped footings descend in increments that match the grade, keeping the foundation anchored at every point. Homeowners planning to expand should review what this work involves at the room addition foundation service page before finalizing scope or budget.
The California Building Code Section R403 governs stepped footing geometry. Each vertical step must not exceed 18 inches. The horizontal distance between steps must be at least 24 inches. Bay Area cities layer seismic amendments on top of that baseline — San Jose and Oakland both have overlays that influence footing depth and rebar requirements. Permitting specifics are covered at room addition foundation permits in San Jose.
This type of work demands precise layout, careful forming, and sequential pours. Done right, a stepped system often performs better than a flat-site foundation — because every footing section bears directly on undisturbed native soil.
Contents
When a Stepped Foundation for a Room Addition Makes Sense on a Sloped Lot
Slope Thresholds That Trigger the Stepped Approach
Not every sloped lot requires a stepped system. The decision depends on how much elevation change exists across the addition footprint. Understanding how Bay Area soil conditions affect room addition foundation design is equally important — the same grade change behaves differently on expansive clay versus decomposed granite.
| Grade Change Across Addition Footprint | Typical Foundation Response | Notes |
|---|---|---|
| Under 12 inches | Standard continuous footing, deepened at low end | Often handled with a single variable-depth pour |
| 12–24 inches | One or two steps | Simplest stepped configuration; often owner-permitted |
| 24–48 inches | Two to four steps | Requires careful forming sequence; engineer drawings recommended |
| Over 48 inches | Multiple steps or pier-and-grade-beam system | Structural engineer required; soils report almost always triggered |
Most hillside communities — Orinda, Moraga, Los Gatos, the Oakland hills — fall in the 24–48 inch range. That puts the majority of Bay Area hillside additions squarely in stepped-foundation territory.
Addition Types That Benefit Most
Stepped foundations appear across a range of addition types. Some scenarios are better candidates than others:
- Single-story rear additions — The most common application. Grade typically drops toward the back of the lot.
- Side additions on corner lots — Slope often runs perpendicular to the house, creating a clean and predictable step sequence.
- Garage expansions — Garage slabs already sit lower than the main structure; a stepped foundation ties the addition into the existing grade naturally.
- Two-story additions — Heavier loads demand deeper, wider footings. Review second-story addition foundation requirements in the Bay Area before finalizing the structural plan — load calculations change everything.
Flat-ground additions can sometimes use a simple slab-on-grade. On sloped sites, that option disappears fast. The tradeoffs are explored in depth at slab-on-grade vs. raised foundation for Bay Area homes.
Engineering and Construction Best Practices
Design Decisions That Drive Cost and Performance
A geotechnical report is not always required by code, but it is always useful. What a soil report tells a foundation engineer directly shapes footing width, depth, and reinforcement specification. Skipping it on expansive clay or imported fill is a common mistake — one that typically shows up years later as cracking and movement.
Key design variables for stepped foundations:
- Footing depth at each step — Must reach undisturbed soil, which varies step by step on uneven terrain. Depth cannot be assumed uniform.
- Rebar continuity — Horizontal steel must run through each step transition without breaks. Lap splices must meet CBC minimums and be properly tied.
- Step height — Maximum 18 inches per CBC R403.1.5. Exceeding this requires a licensed structural engineer's signed drawings.
- Drainage provisions — Weep holes, drain tile, or a French drain behind the uphill footing face are non-optional on steep sites.
- Anchor bolt placement — Each footing section needs properly spaced anchor bolts for the mudsill, regardless of where steps fall in relation to wall layout.
Budget planning matters from the start. Stepped systems cost 25 to 40 percent more than flat-site work for the foundation phase alone. Full cost context is available at room addition foundation costs in the Bay Area.
On any sloped site with more than 24 inches of grade change, engineer-stamped drawings are worth every dollar — inspectors scrutinize stepped footing details closely, and plan corrections mid-pour are expensive mistakes.
Formwork, Concrete, and Sequencing on Slope

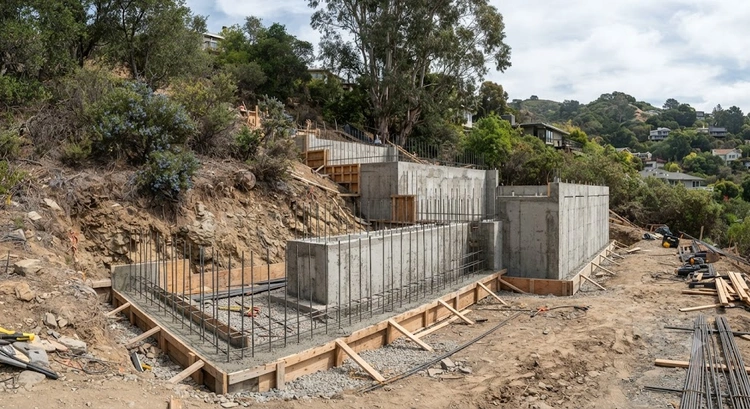

Forming stepped footings is more labor-intensive than standard continuous pours. Each step requires its own form panel, lateral bracing, and a keyway detail to mechanically connect adjacent sections.
Correct sequencing:
- Excavate the full trench following the grade profile. Confirm bearing soil depth at each step location before forming.
- Set forms for the lowest step first. Brace securely — concrete pressure on angled forms is higher than on flat-site work.
- Place and tie all rebar through step transitions before any concrete is placed. Interrupting rebar layout after partial pours creates problems.
- Pour the lowest section first. Allow initial set — two to four hours minimum in typical Bay Area temperatures.
- Form and pour the next step up, maintaining wet contact at the transition joint to avoid cold joints.
- Repeat up the grade until all steps are poured and cured.
- Strip forms after 24 to 48 hours. Inspect every step face for cold joints or honeycombing before backfilling.
Cold joints — where fresh concrete meets fully cured concrete — are a structural weak point. The USGS Earthquake Hazards Program documents the seismic risk across the Bay Area clearly; that risk makes cold joints in foundation concrete unacceptable on any site here.
Protecting a Stepped Foundation Over Time
Drainage: The Top Priority
Water is the primary threat to any foundation on a slope. Stepped foundations create horizontal ledges that concentrate water if drainage is not engineered from day one.
Drainage best practices:
- Grade soil away from each step face at a minimum 5 percent slope for at least six feet.
- Install perforated drain pipe behind the uphill footing face, wrapped in filter fabric to prevent silt migration.
- Route drainage to daylight wherever possible — not to a sump pump. Sump pumps fail; gravity does not.
- Check downspout termination points. Roof water directed toward uphill foundation faces accelerates both erosion and hydrostatic pressure.
- Inspect and clean gutters twice a year. Overflowing gutters on hillside homes deposit large water volumes directly against the foundation zone.
Seismic performance of the broader structure also deserves attention on sloped sites. Existing homes with cripple walls may need reinforcement — seismic retrofit costs in the Bay Area are worth understanding before any addition work begins.
Inspection Schedule and What to Look For
Stepped foundations do not require more maintenance than flat-site foundations — but they do require attention to specific details unique to their geometry.
Annual inspection checklist:
- White mineral deposits (efflorescence) on step faces — signals water migration through the concrete body.
- Cracking or gap formation at step-to-step transition joints — a structural concern that warrants professional evaluation.
- Mudsill condition at each step level — check for moisture damage, rot, or pest activity, which concentrate at grade changes.
- Drain outlet flow during the first heavy rain of the season — confirm outlets are clear and not backing up.
- Soil erosion or surface settlement around the perimeter of each step — early sign of water undermining bearing soil.
Diagnosing Problems Before They Escalate
Cracks: Which Ones Signal Real Trouble
Not every crack in a stepped foundation is a crisis. Location, orientation, and width determine severity. Knowing the difference between normal shrinkage and a structural problem prevents both unnecessary panic and dangerous delay.
- Hairline cracks under 1/16 inch — Common shrinkage cracks. Monitor their width over time; no immediate action needed unless they grow.
- Horizontal cracks on step faces — Moderate concern. May indicate lateral soil pressure exceeding the original design load. An engineer should evaluate.
- Diagonal cracks at step transitions — High concern. Often signals differential settlement between step sections. Do not delay assessment.
- Cracks wider than 1/4 inch anywhere in the footing — Structural evaluation required without delay.
- Cracks with displacement — One side higher or offset from the other. This is an emergency condition requiring immediate structural consultation.
Differential Settlement on Sloped Sites
Differential settlement — where one part of the foundation drops more than adjacent sections — is more common on sloped lots than flat ones. The reasons are structural and geological:
- Soil density varies naturally across a slope; uphill and downhill footings rarely bear on identical material.
- Fill material, if present, compresses unevenly and at unpredictable rates over time.
- Water infiltration softens soil under specific step sections while leaving adjacent sections unaffected, creating uneven bearing.
- Root intrusion from hillside vegetation can disturb bearing soil along individual footing segments.
Early symptoms appear well before visible foundation cracks: doors or windows that stick, floors that feel out of level, gaps forming at baseboard trim. Catching these early dramatically reduces repair scope and cost. Waiting until cracks appear is always the more expensive path.
Frequently Asked Questions
How many steps are typical in a stepped foundation for a room addition on a sloped lot?
Most Bay Area room addition sites with 24 to 48 inches of grade change require two to four steps. Steeper sites may need more. The number is determined by the actual elevation change across the addition footprint and the 18-inch maximum step height established by CBC Section R403.1.5.
Does a stepped foundation cost significantly more than a standard flat-site foundation?
Yes. Expect 25 to 40 percent higher costs for the foundation phase on a sloped lot compared to flat terrain. The premium reflects additional forming labor, sequential pours, extended inspection windows, and reinforcement detailing at step transitions. Full cost context is available at room addition foundation costs in the Bay Area.
Do Bay Area cities require a structural engineer for stepped foundations?
Not universally, but most cities require engineer-stamped drawings when step height approaches CBC maximums, when the addition carries two stories, or when soil conditions are flagged. San Jose and Oakland have seismic amendments that frequently pull stepped foundation work into engineer-required territory. Review specific requirements at room addition foundation permits in San Jose.
How long does a stepped foundation take to construct compared to a flat-site pour?
The sequential forming and pouring process typically adds two to five working days over a continuous flat-site pour, depending on the number of steps, site access constraints, and required cure time between pours. Inspector availability and whether a geotechnical report is required also affect the overall schedule.
Final Thoughts
A stepped foundation for a room addition on a sloped lot is a proven, reliable system — but only when it is designed and built with the grade, soil, and seismic context of the specific site in mind. Homeowners with sloped Bay Area lots who are planning an addition should contact Pro Home Foundation for a site evaluation and written estimate; the earlier the foundation type is confirmed, the smoother the permit and construction process goes.
