Bay Area soil conditions ADU foundation design isn't a detail — it's the determining factor for every structural decision on the project. Our team at Pro Home Foundation has engineered and built ADU foundations across the region, and the single biggest driver of project scope, cost, and timeline is consistently what's in the ground.

Bay Area soil conditions ADU foundation site assessment with geotechnical boring equipment on residential lot
Figure 1 — On-site geotechnical investigation before ADU foundation design in the Bay Area

The Bay Area sits on one of the most geologically varied landscapes in the country. Expansive clay dominates the East Bay flatlands and hills. Soft bay mud lines the waterfront corridors from Richmond to San Jose. Alluvial deposits fill the Santa Clara Valley with inconsistent layering, and undocumented fill from mid-century grading shows up in older neighborhoods with zero warning. No two lots behave the same — and that's not an exaggeration. Our crews have hit dramatically different soil conditions on parcels that share a property line.

Getting this right early saves money, time, and structural headaches. Getting it wrong creates redesigns, permit delays, and sometimes compromised structures that cost far more to fix than to design correctly the first time.

Chart comparing Bay Area ADU foundation types required by soil condition and expansion index rating
Figure 2 — Foundation type selection by soil classification for Bay Area ADU projects

What the Ground Tells Us Before We Design Anything

This is where every well-run ADU project starts — and where too many don't start nearly early enough. Soil conditions dictate foundation type, reinforcement strategy, footing depth, and in some cases the entire structural approach. None of that can be guessed from a visual site walk.

Reading a Geotechnical Report

A geotechnical report translates subsurface conditions into engineering decisions. Our structural engineers treat it as the foundation design brief — everything follows from it. The key data points we pull from every soils report:

  • Allowable bearing pressure — expressed in psf or ksf; determines minimum footing size and configuration
  • Expansion index (EI) — the California Building Code classifies this from Very Low (EI 0–20) to Very High (EI >130)
  • Depth to competent bearing layer
  • Presence of fill material or undocumented fill
  • Liquefaction potential rating
  • Groundwater depth and seasonal variation

For a detailed breakdown of how each section drives structural decisions, the post on what a soil report tells a foundation engineer covers the technical side thoroughly — worth reading before meeting with a geotechnical engineer for the first time.

The Soil Types We Encounter Most

The Bay Area isn't one geological environment. Several distinct soil regimes sit adjacent to each other, and ADU sites can fall into any of them:

  • Expansive clay (Adobe/Vertisol) — dominant in the East Bay hills and flatlands; swells and shrinks with seasonal moisture cycling; the most common foundation challenge we address by volume
  • Bay mud — soft, compressible marine deposits near the shoreline; very low bearing capacity; found in Oakland waterfront, Richmond, and south San Jose
  • Alluvial fans — moderate to good bearing capacity with highly variable layering; common throughout the Santa Clara Valley
  • Rock and serpentinite — high bearing capacity, difficult to drill or excavate; found in the Oakland and Berkeley hills
  • Undocumented fill — present in many older neighborhoods graded decades ago without records; a red flag for any shallow foundation design

What Bay Area Soil Conditions Add to ADU Foundation Costs

Foundation type is the primary cost variable in any ADU project, and soil conditions are what drive foundation type selection. Here's how those numbers stack up in our experience building across the Bay Area.

Foundation Cost by Soil Condition

Soil Condition Typical Foundation Type Estimated Cost (400–600 sf ADU) Key Cost Driver
Low expansion, good bearing (EI <20) Standard slab-on-grade $18,000–$28,000 Straightforward excavation, standard rebar
Moderate expansion (EI 21–90) Thickened-edge slab or raised perimeter $24,000–$38,000 Additional reinforcement, deeper footings
High expansion clay (EI 91–130) Post-tension slab or raised foundation $35,000–$55,000 PT cable system or deeper crawl space footings
Very high expansion / Bay mud Drilled piers with grade beams $50,000–$90,000+ Deep drilling, grade beam forming, extended schedule
Liquefaction zone Deep caissons extending below liquefiable layer $60,000–$100,000+ Drilling depth, structural slab tie-in, special inspection
Undocumented fill present Remove/replace or drill through $40,000–$80,000 Fill volume, bearing depth, haul and disposal

Hidden Costs in Problem Soil

The table above reflects foundation structure costs. Problem soil carries additional line items that surprise most people who haven't built in the Bay Area before:

  • Geotechnical report: $2,500–$5,500 depending on boring depth and count
  • Structural engineering revisions triggered by report findings: $800–$2,500
  • Expansive clay removal and replacement with engineered fill: $15–$40 per cubic yard installed
  • Special inspections for drilled piers, post-tension systems, or high-strength concrete placement
  • Extended construction schedule when drilling rigs and specialty concrete crews are required

Pro tip from our team: Budget the geotechnical investigation before finalizing any ADU project budget — not after. Discovering a $70,000 foundation requirement after designing for a $25,000 slab breaks more projects than any other single factor we see.

The Mistakes That Sink ADU Foundation Projects

Skipping the Geotech Until the City Asks for It

The most expensive mistake we see on ADU projects is treating the soils report as a bureaucratic requirement rather than a design prerequisite. Some applicants move forward on a soil assumption — "the neighbor built a slab, so we'll do the same" — and get stopped at plan check when the building department requests a soils report. That report takes 2–4 weeks to complete. The structural redesign that follows can take another 2–3 weeks. The permit delay alone can kill a construction season.

Our standard practice: order the geotechnical investigation before submitting permit applications, not after. The report costs the same either way, but the timing changes everything downstream.

Mismatching Foundation Type to Soil

Not every lot is a slab candidate. Yet our team still reviews plans submitted for standard slab-on-grade in soil with an expansion index above 90. A slab on expansive clay without EI-appropriate reinforcement, proper sub-slab moisture barrier, and aggregate base is a cracked, heaved slab within a decade. The retrofit costs more than the upgrade would have at the design stage.

Common mismatches we correct regularly:

  • Standard slab on high-EI clay without post-tension or deepened grade beams
  • Shallow spread footings in bay mud where bearing layer is far below standard footing depth
  • Standard perimeter footings on sloped lots with undocumented fill
  • Crawl space foundations without adequate moisture control in high-clay environments

Ignoring Slope and Drainage

ADU lots on slopes introduce soil creep, retaining wall loads, and upslope drainage that can destabilize footings designed for flat ground. A foundation that's structurally sound for a given soil type on a flat lot can be completely inadequate on a 15% grade with the same soil. Slope, drainage, and soil classification are three variables that must be evaluated together — not sequentially and never independently. Our site assessment always addresses all three before any foundation type is selected.

When the Soil Report Comes Back With Red Flags

Not every report is clean. Here's how our team handles the most common problem findings on Bay Area ADU foundations.

Liquefaction Zones

Liquefaction occurs when saturated, loose cohesionless soil loses shear strength during seismic shaking — effectively behaving like a dense liquid. The USGS earthquake hazards program identifies broad swaths of Bay Area flatlands as having moderate to high liquefaction potential, particularly filled areas and bay margin zones.

When a soils report flags liquefaction risk, the structural response follows a predictable sequence:

  1. Shallow spread footings are ruled out — full stop
  2. Drilled piers (caissons) extend below the liquefiable layer to competent bearing soil or rock
  3. Grade beams connect the pier caps at grade level
  4. A structural slab ties into the grade beam system above
  5. Mandatory special inspection covers drilling, concrete placement, and reinforcement verification

High-Expansion Clay

When expansion index exceeds 90 (High) or 130 (Very High), the design response depends on foundation type. For slabs: thickened edges, interior grade beams, post-tension cable systems, and a vapor barrier over aggregate base are non-negotiable. For raised or crawl space foundations, footings must extend below the active moisture zone — typically 18–24 inches in our regional experience — with crawl space moisture control specified in the structural drawings.

The cumulative damage expansive clay inflicts over time is documented in our post on how expansive clay soil damages Bay Area home foundations — useful context for anyone evaluating an East Bay ADU site where clay is the dominant soil type.

Undocumented Fill

Boring logs that reveal fill material with no compaction records narrow the structural options significantly. Our team approaches this with three possible responses:

  • Remove and replace — excavate the fill, backfill with engineered compacted material, test to required compaction; most reliable outcome but highest disruption and cost
  • Drill through — extend piers past the fill to competent bearing; avoids mass excavation but requires geotechnical confirmation of bearing depth and pier capacity
  • Ground improvement — dynamic compaction, stone columns, or chemical grouting; less common at ADU scale but applicable in specific scenarios where removal isn't feasible

Most Bay Area jurisdictions won't permit spread footings bearing on undocumented fill without verification testing. Our team doesn't design to that standard either — it's a risk not worth taking on any project.

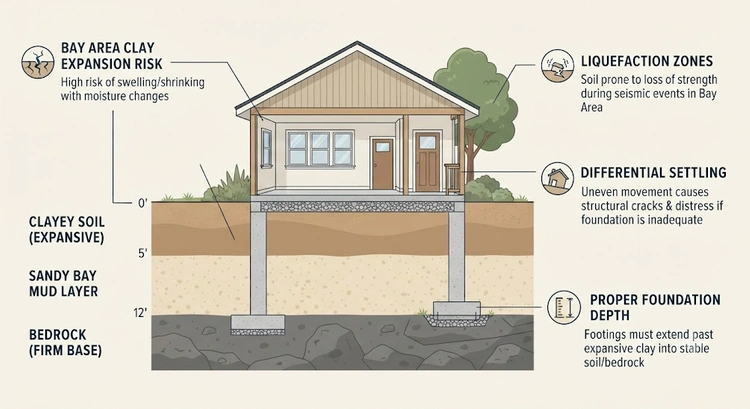

Infographic showing Bay Area soil conditions and corresponding ADU foundation design requirements by soil type
Figure 3 — Bay Area soil classification and ADU foundation design response by condition type

How We Design ADU Foundations Around Bay Area Soil

The Process From Lot to Permitted Plans

  1. Site assessment — walk the lot, document drainage patterns, slope gradient, proximity to existing structures, and any visible distress in neighboring buildings or hardscape
  2. Geotechnical investigation — coordinate with a licensed geotechnical engineer for borings or test pits; specify depth and boring count based on proposed ADU footprint and known regional conditions for that ZIP code
  3. Report review with structural engineer — geotech and structural engineer align directly on bearing assumptions, foundation type, and special requirements before design work begins
  4. Foundation type selection — slab, raised, pier system, or hybrid; driven entirely by report findings, not by cost preference or what happened to work on a nearby project
  5. Structural drawings — foundation plan, footing schedule, reinforcement details, anchor bolt layout, hold-down locations, and connection to framing above
  6. Plan check submission — most Bay Area jurisdictions require the soils report to accompany foundation plans at initial submittal; submitting without it typically triggers a correction that costs 3–4 weeks
  7. Special inspection plan — identify required inspections upfront for drilled piers, post-tension systems, or high-strength concrete; surprises at this stage delay the project
  8. Pre-pour verification — confirm bearing surface condition, rebar placement and embedment depths, vapor barrier integrity, and aggregate base before any concrete is placed

Working With the Right Team

The structural engineer of record and the geotechnical engineer need to communicate directly — not relay information through the general contractor. Our team coordinates that connection from the start of every ADU project we take on. When those two professionals are working from shared assumptions and the same report data, the foundation design is correct the first time. When they don't communicate, revisions happen after plan check approval, which costs real money in both engineering fees and schedule impact.

The right team for a Bay Area ADU foundation project includes a geotechnical engineer with regional experience specific to that soil environment, a structural engineer familiar with local CBC amendments, and a contractor who has built in those soil conditions before — not just in the general area. Regional experience isn't a marketing talking point here. It's the difference between a foundation design that sails through plan check and one that goes back for structural revisions twice.

Frequently Asked Questions

Does every ADU project in the Bay Area require a geotechnical report?

Not every jurisdiction mandates a soils report for every ADU by default, but most Bay Area building departments require one when the structure exceeds certain thresholds or sits in a mapped hazard zone. Beyond the permit requirement, our team recommends a geotechnical investigation on every ADU project regardless — the $3,000–$5,500 cost is negligible against the risk of designing the wrong foundation type for the actual soil conditions on that lot.

What is the most common soil problem our team encounters on ADU sites?

Expansive clay, without question. High-EI clay is present across a large portion of the East Bay and consistently surprises ADU applicants who assumed the soil was stable based on surface conditions or neighboring structures. The seasonal swell-shrink cycle generates significant uplift and lateral pressure on foundations not specifically engineered for it.

Can a standard slab-on-grade work in Bay Area clay soil?

In low-expansion soil (EI below 20), a standard slab with appropriate conventional reinforcement performs well. In moderate-to-high expansion soil, the slab requires post-tension cables or heavily reinforced interior grade beams — what structural engineers call an engineered slab. In very high expansion soil (EI above 130), our team most often recommends a raised foundation over a slab entirely, as the long-term performance difference is significant.

How long does geotechnical investigation take for an ADU project?

Field work — drilling or test pits — typically takes half a day to a full day depending on boring count and depth. The written report follows in one to three weeks. Geotechnical engineers with specific Bay Area residential experience tend to turn around ADU-scale reports faster when projects are scheduled in advance rather than rushed in response to a plan check correction.

What is a drilled pier, and when does our team specify one for an ADU?

A drilled pier (caisson) is a cast-in-place concrete column drilled to a specified depth, extending through poor bearing soil to competent material below. For Bay Area ADU projects, our team specifies piers in liquefaction zones, bay mud sites, and locations with significant undocumented fill — any condition where shallow footings cannot reach adequate bearing within a reasonable depth below finished grade.

Do Bay Area soil conditions affect the framing above the foundation?

Soil conditions primarily drive foundation design, but they influence the framing through structural connection details. High-seismic sites and high-expansion soil conditions often require more robust anchor bolt patterns, code-required hold-downs, and upgraded shear wall specifications — all coordinated between the structural drawings and the soil report's lateral force requirements. The foundation and framing design aren't independent documents on a well-run project.

Is a post-tension slab significantly more expensive than a conventional slab?

Post-tension slabs typically add $8,000–$18,000 over a conventional slab at ADU scale. In high-expansion clay, that cost is almost always justified. The alternative — a conventional slab in expansive soil — routinely experiences significant cracking and differential heaving within the first decade, requiring repair work that exceeds the original upgrade cost and disrupts occupancy.

How do liquefaction zones affect ADU foundation permitting specifically?

In mapped liquefaction zones, the building department may require a site-specific liquefaction hazard study as a supplement to the standard geotechnical report — a more detailed and costly investigation. The structural response (deep pier system, grade beams, structural slab) also adds significantly to design complexity and construction cost, and triggers mandatory special inspection requirements throughout the foundation scope of work.

Key Takeaways

  • Bay Area soil conditions — expansive clay, bay mud, liquefaction zones, and undocumented fill — are the primary driver of ADU foundation type selection, reinforcement strategy, and total project cost, not the size or complexity of the structure above.
  • A geotechnical report should be ordered before permit submission, not after — late reports create redesign delays and budget surprises that kill more ADU projects than any other single factor our team has observed.
  • Foundation costs for ADU projects in problem soil range from $35,000 to over $100,000, a spread determined entirely by subsurface conditions rather than the ADU's footprint or design.
  • The geotechnical engineer and structural engineer of record must communicate directly and work from shared report data — that coordination is what produces a foundation design that's correct the first time through plan check.
