A couple in Walnut Creek hired a contractor, secured permits, and were ready to break ground on a backyard ADU — then the geotechnical engineer flagged unstable fill soil left over from a previous landscaping job. The foundation plan had to be redesigned from scratch. Three extra months and nearly $18,000 in additional costs. Situations like that are avoidable, but only when the real complexity of an ADU foundation on a sloped lot in the Bay Area is addressed early. The region's terrain ranges from gentle grades in the flatlands to dramatic hillsides across the East Bay, South Bay, and Peninsula, and the engineering challenges scale with every degree of slope.
Sloped lots introduce variables that flat-lot projects simply don't face. The grade determines which foundation type is even feasible. The soil conditions — whether it's expansive clay, compacted fill, or stable bedrock near the surface — dictate footing depth and reinforcement requirements. And in a region with significant seismic activity, every hillside foundation has to handle vertical loads and lateral loads (forces pushing sideways) simultaneously. These aren't minor engineering footnotes. They are the core of the project.
This post breaks down what actually drives the difficulty of building on sloped terrain: from the early design decisions that shape the entire project, to the long-term maintenance factors that keep a hillside ADU foundation stable for decades.
Contents
Foundation Decisions That Pay Off Early on a Sloped Lot
Get the Geotechnical Report Before Anything Else
The single most important document for any sloped-lot ADU project is the geotechnical investigation report — also called a soils report or geotech report. This study examines soil composition, load-bearing capacity (how much weight the soil can support per square foot), groundwater depth, and slope stability at the specific project site. Without it, no structural engineer can confidently specify foundation dimensions, depth, or type.
Bay Area soil conditions vary dramatically over short distances. One side of a ridge may have stable bedrock close to the surface. The other may have deep deposits of expansive clay — a soil type that swells when wet and shrinks when dry, creating constant movement beneath any structure resting on it. Fill soil (soil that was placed on a site artificially, often during past grading or landscaping work) is common on older hillside lots and presents particular risk because it compresses unevenly under load, leading to differential settlement (uneven sinking) over time.
A geotech report typically costs $2,500–$6,000 depending on the site and the number of test borings required. That investment consistently prevents far larger expenses during construction or after. Most Bay Area jurisdictions require one for any ADU on a hillside lot above a certain grade threshold, so it's usually a permit prerequisite as well.
Pro insight: The geotech report should be ordered before finalizing the ADU floor plan. Soil findings may shift where on the lot the structure should sit — and repositioning a plan on paper costs nothing compared to repositioning a foundation that's already been permitted and designed.
Match the Foundation Type to the Slope

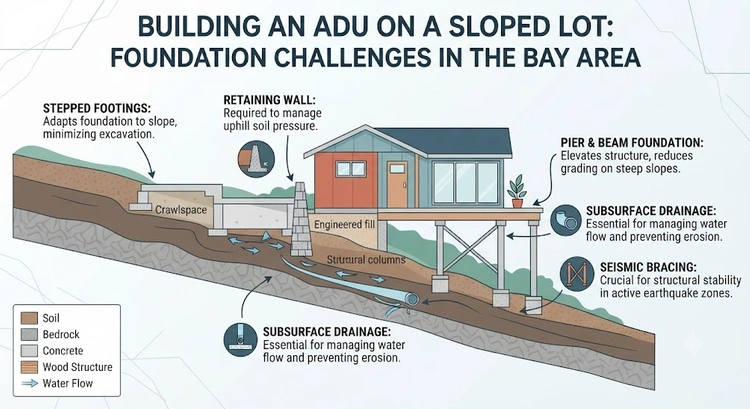

Once the soils report is in hand, a structural engineer specifies the foundation type. The slope angle is usually the deciding factor. Here's how the options typically break down:
- Shallow grades (under 10%): Slab-on-grade or a raised perimeter foundation are both viable. Excavation is minimal and costs stay manageable.
- Moderate slopes (10–25%): A stepped foundation — footings constructed at different elevations following the terrain — or a stem wall system (a short concrete wall that sits on the footing and supports the structure above) becomes necessary. The stepped foundation approach used for room additions on sloped Bay Area lots follows the same engineering logic applied directly to ADU construction.
- Steep slopes (over 25%): Drilled pier systems (deep cylindrical concrete columns bored into stable soil or bedrock), retaining walls, or a combination are typically required. These anchor the structure below the unstable surface layers entirely.
For a foundational comparison of the two most common ADU foundation types before factoring in slope at all, the post on slab-on-grade vs. raised foundation for backyard ADUs covers the core trade-offs in detail.
What Homeowners Handle and What Engineers Decide
Site Assessment and Permit Prep
Homeowners entering a sloped-lot ADU project often underestimate how much professional coordination happens before any concrete is poured. The permitting phase involves multiple licensed professionals and multiple submissions to the local building department — and on a hillside site, plan check comments frequently require revisions that flat-lot projects never encounter.
Here's what homeowners typically coordinate or manage directly:
- Hiring a licensed geotechnical engineer for the soils report
- Engaging a licensed architect or draftsperson to produce the site plan, floor plans, and foundation plans
- Submitting permit applications and responding to plan check comments
- Scheduling inspections at each required construction phase
Many Bay Area cities — including San Jose, Oakland, Berkeley, and Walnut Creek — have hillside grading ordinances, which are local rules governing how much soil can be cut (removed) and filled (added) on sloped lots. These rules can restrict the scope of grading, directly limiting what foundation design is feasible on a given property. Checking with the local planning department early in the process avoids expensive redesigns later.
Structural Engineering and Load Calculations
This is where the homeowner's coordination role ends and the engineer's technical work begins. Structural engineers calculate how every load — dead loads (the building's own weight), live loads (occupants and furnishings), and seismic loads — transfers through the foundation into the ground. On a sloped site, those calculations grow more complex because gravity acts at an angle relative to the hillside, and any soil retained behind a stem wall or retaining wall creates lateral pressure (horizontal force pushing against the wall).
Key engineering decisions for a sloped-lot ADU typically include:
- Footing depth and width, determined by soil bearing capacity from the geotech report
- Reinforcement schedule — rebar sizing and spacing to meet both structural and seismic code requirements
- Stem wall or retaining wall design, when the grade requires one
- Anchor bolt patterns for connecting the framed structure to the foundation
- Drainage provisions to relieve hydrostatic pressure (water pressure that builds up behind walls) during the rainy season
The USGS Earthquake Hazards Program classifies most of the Bay Area as a high seismic hazard zone. That designation means structural engineers must factor in ground shaking and potential slope instability during an earthquake — influencing footing depth, rebar requirements, and the type of anchor connections specified at the foundation-to-framing interface.
Keeping the Foundation Sound After Construction
Drainage Systems That Work With the Slope
Water is the number one long-term threat to any hillside foundation. Slopes naturally concentrate surface runoff, and when that water pools around a foundation, serious problems follow: soil erosion beneath footings, hydrostatic pressure against stem walls, and accelerated concrete deterioration. The drainage system installed during construction is what stands between a stable foundation and a costly repair bill years down the road.
Effective drainage on a sloped ADU lot typically includes:
- Perimeter drains (also called French drains) — perforated pipe buried alongside the footing to capture and redirect groundwater before it reaches the foundation wall
- Swales — shallow channels graded into the landscaping to guide surface runoff away from the structure
- Coarse gravel backfill behind retaining walls, which lets water move freely rather than building pressure against the wall face
- Downspout extensions that deposit roof water well away from the foundation perimeter
These systems require periodic upkeep. Perimeter drains can clog with silt and roots over several years. Swales fill with debris after storms. Hillside property owners should inspect all drainage paths at least once a year, especially after the rainy season ends and problem areas become visible.
Warning: Redirecting downspouts so they drain toward a slope above a retaining wall or foundation is one of the most common causes of retaining wall failure and foundation undermining on hillside properties — concentrated roof runoff carries far more volume than dispersed rainfall.
Watching for Early Signs of Movement
Even a well-engineered hillside foundation can show distress if underlying conditions change over time. Seasonal soil movement, a drainage system that fails gradually, or slow erosion can stress the structure in ways that aren't immediately visible. Early detection keeps repairs manageable. Problems caught at the crack stage cost a fraction of what problems cost at the settlement stage.
Signs to monitor on a hillside ADU foundation:
- New cracks in the stem wall or slab — diagonal cracks at corners are particularly significant, as they indicate differential settlement
- Doors and windows that suddenly stick or develop visible gaps at the corners
- Visible separation between the foundation and the framing above
- Any noticeable tilting of the structure relative to the surrounding lot grade
A visual walkthrough every six months, combined with a professional foundation inspection every few years, is a practical maintenance schedule for any hillside ADU.
ADU Foundation on a Sloped Lot in the Bay Area: Real Project Scenarios
Mild Slope Projects (Under 10% Grade)
On a lot with a mild grade — roughly one foot of drop for every ten feet of horizontal distance — ADU foundation work is relatively straightforward compared to steeper terrain. A slab-on-grade is often viable with modest grading. A raised perimeter foundation with a crawl space underneath can accommodate the grade without major excavation or retaining work.
The main added cost compared to a flat lot is the grading and compaction. The contractor needs to cut and fill soil to create a level building pad. If the soils report flags unstable fill beneath the proposed footprint, over-excavation and replacement with compacted engineered fill (professionally placed and tested fill material certified to specified bearing capacity) is required before any concrete work begins.
On a typical mild-slope project, total foundation costs for a 400–600 sq ft ADU run $20,000–$45,000, depending on soil conditions, drainage requirements, and local labor rates.
Moderate to Steep Slope Projects (10–30%+ Grade)

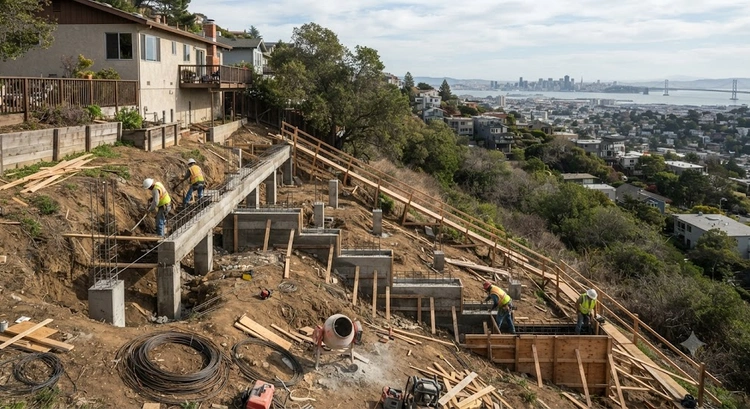

Steeper slopes change the foundation calculus entirely. A stepped foundation system is generally required for grades above 10%. With a stepped design, the footing descends in a stair-step pattern down the hill, with each vertical step no more than 18 inches tall and each horizontal run no less than 6 inches — standard minimums per the California Building Code. This approach keeps each section of footing in undisturbed, stable soil without requiring excavation of the entire hillside.
For slopes over 20–25%, drilled piers become the preferred solution. Piers are bored through poor surface soils entirely, transferring structural loads to stable material well below grade. They also perform better during seismic events because they're anchored below the zone where soil movement is most active during ground shaking.
| Slope Grade | Common Foundation Type | Typical ADU Cost Range | Key Requirement |
|---|---|---|---|
| Under 10% | Slab-on-grade or stem wall | $20,000–$45,000 | Grading and compaction |
| 10–20% | Stepped foundation | $35,000–$65,000 | Structural plan with step dimensions |
| 20–30% | Stepped foundation + retaining wall | $55,000–$90,000 | Geotech report + drainage plan |
| Over 30% | Drilled piers + grade beam | $80,000–$140,000+ | Deep geotech study + special inspection |
Cost ranges reflect Bay Area market conditions and vary with site-specific soil conditions, material costs, and labor. Always obtain site-specific contractor bids before budgeting a hillside ADU project.
Building for the Long Haul on a Hillside Lot
Seismic Considerations Specific to Hillside ADUs
The Bay Area sits adjacent to several major fault systems. The Hayward Fault alone runs through densely populated portions of Fremont, Hayward, Oakland, and Berkeley. For any ADU project on a hillside, seismic engineering isn't a premium upgrade — it's a code requirement and a practical necessity that shapes nearly every foundation decision.
On hillside sites, seismic risk takes two distinct forms. The first is direct ground shaking, which every foundation must resist through reinforcement and anchor connections. The second is slope instability — the risk that strong shaking triggers lateral soil movement or a shallow landslide across the hillside. This is part of why drilled pier foundations are favored on steep slopes: they bypass unstable surface layers and anchor into bedrock, giving the structure a stable base even if surrounding soil shifts during an event.
Engineers specify seismic tie-down hardware — including anchor bolts and hold-down devices — at the connection between the foundation and the framing above. Getting those connections installed correctly during initial construction is far simpler than retrofitting them later. The framing phase is the right time to verify that hardware is properly placed and secured, a process detailed in the post on framing inspections in the Bay Area.
Coordinating Foundation and Framing From the Start
One of the most consistent mistakes on hillside ADU projects is treating the foundation and framing as separate contracts to be handed off sequentially. On a sloped lot, the connection between these two systems is tighter than on flat ground. The framing must account for the varying elevations created by a stepped foundation. Anchor bolt layouts must match the framing plan exactly. Hold-down hardware has to be embedded in the right location in the concrete before any forms are stripped.
When foundation and framing contractors work from the same engineered drawings from day one, errors at connection points are far less likely to occur. Misaligned anchor bolts, stem walls that don't match the framing layout, or hold-down hardware installed at the wrong elevation can require corrections that delay a project by weeks and add costs that were never in the budget.
For ADU projects requiring both foundation and framing work, Pro Home Foundation's ADU foundation services include coordination with framing teams from the design phase through final inspection, treating both systems as one integrated structure rather than two separate scopes of work that need to be reconciled on-site.
Key Takeaways
- A geotechnical investigation report is the essential first step for any ADU foundation on a sloped Bay Area lot — soil conditions vary widely across the region and directly determine which foundation types are viable.
- Slope grade is the primary driver of foundation type: mild grades allow slabs or stem walls, moderate slopes require stepped foundations, and steep hillsides typically need drilled pier systems anchored in stable soil or bedrock.
- Drainage maintenance is the most critical long-term factor on hillside properties — water infiltration and hydrostatic pressure cause more foundation failures over time than any shortcoming in initial construction.
- Coordinating foundation and framing design from the beginning of a hillside ADU project prevents costly errors at connection points and avoids the delays that come from reconciling two independently designed systems on-site.
