The California Residential Code mandates a minimum of three separate framing-related inspections before any wall can be closed with drywall — yet our team routinely sees projects arrive at the first inspection having planned for only one. A framing inspection Bay Area contractors face is among the most layered in California. Seismic Zone 4 requirements, engineered structural systems, and city-specific amendments stack on top of base code in ways that catch unprepared builders every time. Our team at Pro Home Foundation handles home and ADU framing across the Bay Area, and this guide walks through every inspection stage with no filler.

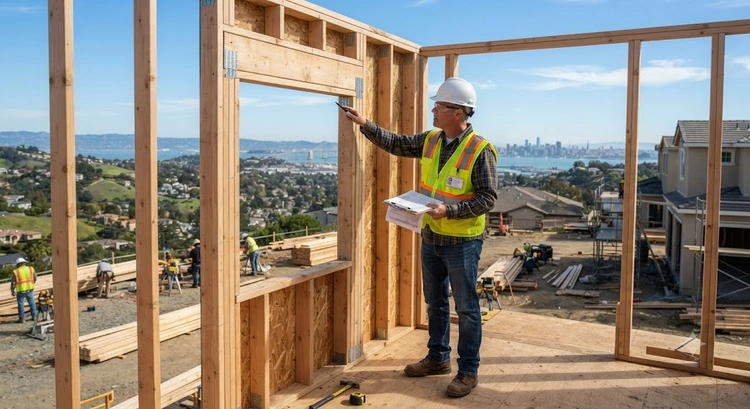

framing inspection Bay Area — inspector reviewing wood stud wall framing on new residential construction
Figure 1 — A Bay Area building inspector reviews rough framing on a new residential project before drywall installation.

Bay Area inspections run on inspector-available schedules — not contractor schedules. Most jurisdictions require 48 to 72 hours of advance notice. Missing that scheduling window adds days, sometimes weeks, to any project. Our team factors inspection lead times into every framing schedule before ground breaks.

The stakes are high. A failed framing inspection can mean opening walls after drywall installs. Correction costs far exceed the original framing cost in those cases. Our team has documented six-figure correction bills on projects where framing errors went undetected until final inspection. Prevention starts with understanding what inspectors check at each stage — before the inspector shows up.

How a Bay Area Framing Inspection Unfolds, Stage by Stage

Bay Area framing inspections do not happen all at once. They follow a sequenced schedule tied to construction milestones. Each stage has a specific window. Miss one and the project stalls until a reinspection can be scheduled.

Foundation-to-Frame Transition

Before framing begins, the foundation must pass its own inspection. Anchor bolts and sill plate connections are verified at this stage — after the foundation inspection passes but before any wall framing begins. Inspectors confirm bolt placement matches the approved structural plans. Spacing, embedment depth, and washer size all get checked.

Foundation and framing inspections are tightly linked. A foundation deficiency discovered after framing has started creates a cascade of corrections that no schedule can absorb cleanly. Our team covers this relationship in detail in our post on why Bay Area homeowners book foundation and framing together.

  • Anchor bolts: typically ½" or 5/8" diameter per structural drawings
  • Sill plate treated lumber (PT marking must be visible to inspector)
  • Mudsill-to-foundation connection must match the engineered plan set exactly
  • Embedded holdowns confirmed before any concrete cures — corrections after that point require core drilling

The Rough Framing Stage

Rough framing inspection covers walls, floors, and roof framing before any sheathing, insulation, or mechanical work covers structural members. This is the most comprehensive framing inspection stage. Inspectors spend the most time here, and correction notices are most common at this point.

The California Building Standards Commission publishes the base code requirements, but Bay Area jurisdictions — San Jose, Oakland, San Francisco, Fremont, and others — layer on local amendments that carry the same enforcement weight. Our team pulls the local amendment sheet for every jurisdiction before framing starts, not the week of inspection.

  • Stud spacing: 16" or 24" on center, confirmed against approved plans
  • Double top plate nailing at joints verified (minimum overlap per code)
  • Window and door header sizes confirmed against structural schedule
  • Floor joist spans and bearing verified against plan dimensions
  • Roof rafter size, spacing, and ridge beam connection inspected
  • Notching and boring limitations for utilities — code limits exist and inspectors enforce them
  • Bridging or blocking for floor joists per span table requirements

Shear Wall and Hold-Down Inspection

This is the most critical framing inspection in the Bay Area. No other region in California carries the same seismic exposure. Shear walls (structural wood panels that resist sideways earthquake forces) are inspected panel by panel against the structural engineer's drawings — not just against generic code minimums.

Our team covers the full scope of these requirements in our guide to seismic framing requirements for new homes in the Bay Area. The summary: nailing patterns on shear panels are specified in a schedule, every panel gets checked individually, and substitutions require a written engineering revision.

  • Structural plywood or OSB: panel thickness and grade confirmed
  • Edge nailing: 2", 3", or 4" spacing per the project's shear schedule
  • Hold-down hardware: size, bolt diameter, and installation method all checked
  • Drag struts and collectors verified at each floor level
  • Continuous sheathing at corners confirmed where required

Pro insight: Keep the structural engineer's shear wall schedule taped to the plan set and available on site. Inspectors compare each panel against the schedule individually — a missing schedule document wastes the inspection visit.

Pre-Drywall Sign-Off

The pre-drywall inspection is the final framing checkpoint before walls close. Mechanical, electrical, and plumbing rough-ins must also pass at this same stage. Most Bay Area jurisdictions inspect all rough-in trades together in one visit — a failed plumbing rough-in holds up the framing sign-off even if framing itself is perfect.

  • Fire blocking at floor levels and at the top of stud walls confirmed
  • Penetrations through fire-rated assemblies sealed with listed materials
  • Energy compliance blocking: insulation baffles and eave blocking installed
  • Access panels for plumbing cleanouts and valves confirmed accessible
  • Draft stopping in attic spaces over concealed spaces verified

New Homes, ADUs, and Additions: How Inspections Differ

The inspection sequence stays the same across project types, but scope, complexity, and city requirements shift considerably. Our team works across all three categories and the differences affect scheduling, cost, and preparation.

New Home Construction

New homes trigger the full framing inspection sequence without exception. Three to four separate framing visits are standard across Bay Area cities. San Jose requires special inspection by a third-party inspector on engineered shear systems. San Francisco adds seismic anchorage verification steps not found in neighboring jurisdictions.

New home framing inspections overlap with foundation inspections in the early stages. Coordinating both permit tracks efficiently is one of the main advantages experienced general contractors bring to a new build. Our guide on Bay Area foundation permits for new home construction shows how those permit timelines connect.

ADUs and Room Additions

ADU and room addition framing inspections focus heavily on tie-ins between old and new framing. Inspectors scrutinize connection points between existing structure and new construction. Existing framing that doesn't meet current code can trigger mandatory upgrades — a cost that surprises most ADU owners who budget only for new work.

State ADU law has accelerated permit timelines in recent years, but framing inspection requirements have not relaxed. Our guide on Bay Area ADU framing permits details what most builders need to have in hand before breaking ground.

Project Type Framing Inspection Stages Key Focus Areas Typical Inspector Lead Time
New Home 3–4 stages Shear walls, hold-downs, roof framing, sill plates 48–72 hours per visit
ADU (Detached) 2–3 stages Floor framing, wall connections, lateral resistance 48–72 hours per visit
Room Addition 2–3 stages Tie-ins to existing framing, headers, shear continuity 48–72 hours per visit
Small Commercial 4–5 stages Structural connections, diaphragms, special inspections 24–48 hours with pre-scheduling

What Inspectors Check: Standard Requirements vs. Complex Structural Details

Most people know inspectors look at stud spacing. Few understand how detailed the checklist gets on engineered framing systems. Our team breaks this into two tiers: baseline items that appear on every inspection and advanced items tied to project-specific engineering.

Standard Checklist Items

These are the baseline items every inspector checks on every framing project, engineered or not. Getting these wrong is an entirely preventable failure.

  • Stud size and spacing: 2x4 at 16" on center or 2x6 at 24" on center, per approved plans
  • Double top plate laps: minimum 48" at corners and wall intersections
  • Jack and king stud counts at all openings: must match the structural schedule
  • Beam pockets: correct bearing length and no splits in the bearing seat
  • Sheathing nailing: schedule-specified nail type, diameter, and spacing
  • Fire blocking: solid blocking at 10-foot vertical intervals within wall cavities
  • Notch and bore limits: no more than one-third stud depth for notches, 40 percent for bored holes

Complex Structural and Engineered Details

On engineered designs — which most Bay Area new homes and ADUs require — inspectors work directly from the structural engineer's drawings. Standard code minimums do not govern these projects; the engineer's drawings and specifications govern.

  • Moment frame connections: bolted connections per detail sheet, specific torque values required
  • Drag strut nailing at floor and roof diaphragms: schedules specify nail type and pattern separately from shear walls
  • Pre-fabricated hardware: specific manufacturer part numbers required — no field substitutions
  • High-load holdowns: anchor bolt embedment depth confirmed by a third-party special inspector, not just the city inspector
  • Tall wall framing: engineered stud sizing and lateral bridging requirements differ from standard prescriptive code

Warning: Swapping a "similar" hardware piece for the one specified on structural drawings is a code violation — even if the substitute looks stronger. Our team never substitutes hardware without a written engineering revision attached to the permit set.

How to Pass Every Framing Inspection Bay Area Cities Require

Re-inspection fees across Bay Area jurisdictions run from $150 to over $500 per visit. Beyond the fee, failed inspections delay occupancy, stall other trades, and create schedule compression that costs far more than the re-inspection itself. Our team follows a consistent pre-inspection protocol on every project.

Preparation Before Inspection Day

  • Pull the city's framing inspection checklist from the building department website before framing starts — not the day before the inspection appointment
  • Mark shear wall panel nailing spacing using chalk lines before sheathing goes on — inspectors expect visible nailing patterns, not covered panels
  • Verify all hardware part numbers against the structural drawings before ordering — substitutions after installation require correction notices
  • Confirm all rough-in trades (electrical, plumbing, mechanical) are complete before scheduling the pre-drywall inspection — one failed trade holds all others
  • Self-inspect the framing the day before. Walk every wall, floor, and roof area with the framing superintendent. Find problems before the inspector does.
  • Photograph all holdown installations, hardware, and critical connections before sheathing covers them

What to Have Ready on Site

  • Approved permit set, fully stamped and on site — not a digital copy on a phone
  • Structural engineer's detail sheets (often a separate document from the architectural plan set)
  • Special inspection reports from third-party inspector, if required by the permit conditions
  • Product data sheets for proprietary hardware installed on the project
  • Ladder access to all attic spaces, crawl spaces, and elevated framing cleared and ready
  • Framing crew on site and available — minor corrections made immediately prevent a return visit

The Most Common Framing Inspection Failures We See

Our team has tracked framing corrections across dozens of Bay Area projects. The same failures appear repeatedly. None of them are complicated to prevent — they are all the result of rushing or skipping pre-inspection review.

Nailing Pattern and Hardware Errors

Nailing failures are the leading cause of framing re-inspections across Bay Area jurisdictions. This entire category is preventable with a pre-inspection walk.

  • Wrong nail diameter or length: 8d versus 10d is a common field swap. The structural schedule specifies exact nail type — field substitution is not acceptable.
  • Over-driven nails on shear panels: breaking the face veneer of structural plywood voids the panel's rated shear value. Pneumatic guns set too high are the consistent culprit.
  • Missing edge nailing at panel boundaries: field nailing gets done, boundary nailing gets skipped by fatigued crews near end of day.
  • Holdown anchor bolts installed off-center or at insufficient embedment depth — discovered after concrete cures.
  • Missing or under-nailed joist hangers at floor connections — inspectors count every nail hole on pre-fabricated hardware.

Header and Blocking Deficiencies

Header and blocking failures are the second most common correction category. Many stem from using prescriptive code table values when the project requires engineered values instead.

  • Undersized headers at garage door openings — the single most common failure our team sees on room additions and garage conversion projects
  • Missing cripple studs below window sills at openings wider than code threshold
  • Fire blocking absent at the top of stud walls in two-story projects — often skipped in the rush to frame upper floors
  • Blocking missing at lateral load transfer points, particularly at floor-to-wall shear connections
  • Beam bearing length below plan-specified minimum — the engineer's required bearing often exceeds the code minimum

Pre-Inspection Walkthroughs: Worth the Cost or Not?

A pre-inspection walkthrough brings a qualified third-party reviewer — often a retired building official or licensed structural engineer — to the site before the city inspector arrives. Our team has participated in these on both sides of the review. Our position is clear: the value depends entirely on project complexity and crew experience.

The Case For Pre-Inspection

Pre-inspections are worth the cost on any project with engineered framing, a first-time general contractor, or high consequence for schedule delay. The math is direct: a $300–$500 pre-inspection fee versus a $400+ city re-inspection fee plus 3–7 days of schedule compression.

  • Identifies nailing and hardware issues before drywall permanently covers them
  • Gives the framing crew a chance to self-correct without a formal city correction notice on the permit record
  • Reduces uncertainty on city inspection day — no surprises from an unfamiliar inspector
  • Creates a documented compliance record that supports the owner's files and future permit applications on the same property
  • Particularly valuable on projects with multiple engineered shear lines and complex hardware schedules

When Most Builders Skip It

On simple, non-engineered projects with experienced crews, pre-inspections add cost without proportional return. Our team skips pre-inspections on:

  • Simple room additions under 400 square feet with no engineered framing components
  • Projects where the framing superintendent has passed 10 or more inspections in that specific jurisdiction
  • Garage conversion ADU projects with minimal structural modification to existing framing

The decision comes down to two variables: project complexity and crew experience. Engineered system plus new crew: always get a pre-inspection. Simple project plus experienced crew: skip it. Our team does not recommend a one-size approach.

Next Steps

  1. Download the framing inspection checklist from the building department website for the specific city where the project is located — requirements vary between San Jose, Oakland, San Francisco, and other Bay Area jurisdictions.
  2. Confirm with the structural engineer whether the project requires third-party special inspection at any stage — this is a permit condition that must be arranged before framing starts, not after.
  3. Schedule a pre-framing coordination meeting with the framing crew superintendent to review the shear wall schedule, hardware list, and nailing requirements before the first board goes up.
  4. Photograph all foundation anchor bolt installations, holdowns, and embedded hardware before concrete cures or framing covers them — these photos serve as documentation if questions arise at inspection.
